|
|
Status
|
Construction scheme
(future) |
|
Where
|
To widen
the last remaining 2-lane single
carriageway section of the Belfast to
Carrickfergus Road to 4 lanes. |
|
Total
Length
|
2.35km / 1.46 miles |
|
Dates
|
Belfast Metropolitan
Transport Plan prioritises scheme Nov
2004.
Public consultation
March 2005.
Public inquiry held
8-16 October 2007.
Results of public
inquiry published September 2008.
Approval to release
tenders for construction - 30 Nov 2010.
Scheme put on hold - 13
Jan 2011.
Scheme given go-ahead once again - 14 Feb
2012.
Construction to begin - "early 2013" (as
of Feb 2012)
Construction likely to
last 2 years.
|
|
Cost
|
£57m as of Feb 2012
(changed
from £55.2m as of Oct 2007;
£41.1m; originally £21.1m) |
|
Photos
|
See below for photos. |
|
See
Also
|
General
area map
Official
web site on scheme - Roads Service
Roads
Service information leaflet on
scheme [216kB]
Shore
Road Action Group - fighting against
the "online" option.
A2 Hazelbank to
Station Road on this site
A2
Greenisland to Carrickfergus on this
site
|
The A2 Shore Road forms the route from the end of
the M5 all the way to Carrickfergus, taking it
through the commuter suburbs of Whiteabbey,
Jordanstown and the village of Greenisland. A
short section at the Whiteabbey end and a section
near Carrickfergus are dual-carriageway, while
most of the rest is 4-lane single-carriageway. The
exception is the short section through Greenisland
village which is 2-lane single carriageway. This
is a serious bottleneck and causes huge delays and
much stress every day for the vehicles which
travel along the route (26,000 per day north of
Greenisland; 35,000 south of Greenisland).
The new road will follow the route shown in the
below map (the other two options were rejected).
For those who are interested, the Roads Service
have more detailed maps here.

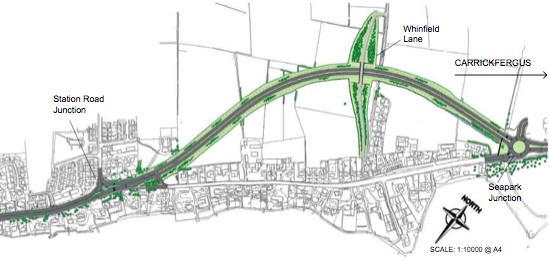

Map of proposals (southern end)
released to the public in March 2007.

Map of

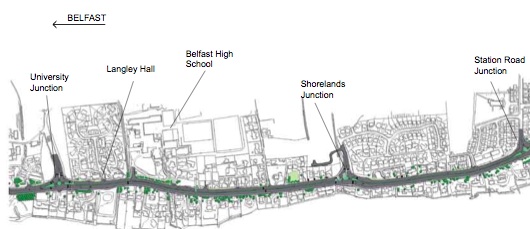

proposals (northern end) released to the public in
March 2007.
The road will be built
to dual-carriageway standard with two lanes each
way. There will be four roundabouts, the first
three of which will be signalised:
- The Shore Road entrance to the University of
Ulster (currently a T-junction).
- At "Shorelands" (currently a T-junction).
- At Station Road, Greenisland (currently
traffic lights).
- At Seapark (near the police station entrance).
At all other junctions,
drivers will be required to turn left only and use
the next roundabout along to turn round if they
wished to turn right. An exception will be made at
Station Road to allow buses only
to turn right into the former Shore Road from the
new road.
For completeness, the
three options considered before the decision was
made were:
- Inland Option: routing a
new 4-lane road inland, to the west of the
existing road. This would involve the demolition
of 30 homes and impact on 5 gardens. It would
utilise fields and some largely undeveloped land
attached to 2 schools and 2 churches.
- Online Option: widening the
existing road to 4 lanes. This would involve the
demolition of 27 homes and impact on 41 gardens.
- Combined Option: widen the
Belfast end of the existing road, and build a
new road inland for the part of the route from
Station Road to Seapark. This would involve the
demolition of 23 homes and impact on 25 gardens.
With thanks to Shane McKee for a correction to
the above information.
Progress
13 Mar 2012:
Following February's announcement, Roads Service
have lost little time putting this scheme out to
tender. The tendering process will be done in two
stages. The initial stage is just to compile a
list of companies that Roads Service are confident
could do
the work. The second stage will be the formal
tender, where one contractor will be selected. The
advertisement
for the initial stage went live on 1 March,
and the selected companies will be notified on 11
June 2012. This will then be followed by the
second stage, which ought to see a final
contractor selected before the end of 2012, with
work to begin on the ground early in 2013. The
scheme has already passed its public inquiry and
is good to go - it is only the necessity to go
through this tendering process that means work
can't begin straight away. (This problem does not
affect the A5 and A8 schemes since they were done
differently, with the contractors appointed during
the design stage).
14 Feb 2012:
Today saw a major
announcement about how the money freed up by
Dublin's postponement of money for the A5. Perhaps
the least-surprising element is that this scheme
will now go ahead. It was within days of going out
to tender in January 2011 when it was put on hold.
As a relatively cheap scheme (compared to the A5,
A6 and A8) it was the most obvious scheme to get
the go ahead, and this is what has happened. The
scheme has already passed its Public Inquiry (held
in 2007), so that is not an obstacle. However the
procurement process (to appoint a contractor) has
not happened, so this will take some months. This
is probably the reason that the scheme is now due
to go to ground "early in 2013". With an estimated
timescale of two years, this means that the road
could be complete and in use by Spring 2015. The
people of Carrickfergus will be celebrating
tonight. In terms of cost, the DRD
press release gives the cost as vaguely between
"£50m-60m", whereas the OFMDFM
press release gives it more specifically at
£57m. The latter figure is very close to the
figure of £55.2m previously quoted by DRD,
so I am assuming it is correct.
12 November 2011:
Last Wednesday's announcement that the Irish
government was delaying its promised £400m
towards the A5 means that the A5 now cannot
proceed on the timescale envisaged, ie before
2016. This has created confusion as to how
Stormont's cash that has suddenly been released
should be spent. There are lots of road schemes in
planning, but due to the length of time the legal
processes take, only four schemes could proceed in
the near future. These are the ones that have had
their public inquiries and are:
- A2 dualling Greenisland (ie this scheme)
- A6 dualling Randalstown to Castledawson
- A8 dualling to Larne
- and of course, the big A5 scheme that is now
on the long finger.
It is therefore the first three of these that I
believe have the highest chance of proceeding soon,
and thus I would not be surprised if the coming
months see movement on the Greenisland scheme.
5 June 2011:
This scheme was the subject
of an "adjournment debate" in Stormont (the
first of the newly elected Assembly) which was
held on 30th May. During this various politicians
from East Antrim and further afield expressed
their dissatisfaction with the sudden halt that
was called to this scheme in January. In
particular they highlight the problem of blight.
Under blight legislation (designed to prevent
people being stuck with an un-sellable house for
years and years) Roads Service had already bought
25 properties and some of these have been
demolished. During the debate the new "Roads"
Minister Danny Kennedy explained in some detail: "Consultations
with affected landowners to finalise and agree
accommodation works were also substantially
completed in 2010. My Department is, therefore,
in a position to complete the final statutory
vesting order as soon as finance becomes
available. The compulsory purchase of land for
the scheme is currently valued at £17
million. My Department’s Road Service has
acquired 25 residential properties under blight
legislation. A number of those properties have
been demolished in order that they do not become
derelict and vandalised. Any surplus land or
property not required for the scheme will be
declared surplus and disposed of on the open
market. That is normally carried out upon
completion of the scheme. However, my
Department’s Road Service is considering early
disposal of some properties in order to minimise
security and maintenance issues associated with
them. In the meantime, every effort is being
made to secure and maintain all acquired
properties."
While the new Minister has
committed to reviewing the A5 scheme once the
public inquiry has reported, he has not offered
any immediate hope for this scheme. All he said
was: "Schemes such as the A2 Shore Road tend
to take more than one year in construction, and
funding in year 5, and possibly beyond, would be
required before I could give approval for
construction to commence. The funding in those
years will not become clearer until further work
has been completed to develop the third edition
of the investment strategy for Northern Ireland,
which, I understand, is due to conclude later
this year." So it's a case of "watch this
space".
14 May 2011: On Friday the
d'Hondt system of sharing Ministries in the newly
convened Northern Ireland Assembly resulted in the
Department for Regional Development Ministry
(which includes roads) falling to the Ulster
Unionist Party (previously it was held by Sinn
Fein's Conor Murphy). Of relevance to this scheme
is that the UUP election manifesto included a
committment to "advocate a refocusing on the
need to commission the A2 project at
Greenisland, rather than the A5 Western
Transport Corridor" (UUP
2011 manifesto). This does not
mean that there will be an overnight change to the
timing of this scheme, but it does suggest that
the incoming minister will be more sympathetic to
the need for this scheme than the outgoing one.
14 Jan 2011: In a Roads
Service Board meeting on 30 November 2010 it
was revealed that the initial pre-qualification
tender process (which chooses which companies will
be allowed to tender for construction) has now
been completed. At the same meeting the Board "granted
approval for tender documents to be released"
which basically meant that the scheme was ready
for construction. However, yesterday the DRD
(which includes Roads Service) published
their budget for the period 2011-2015 and
this has revealed that due to lack of money this
scheme has now been put on hold,
seemingly until at least 2015. This is very sad
news for the scheme, given that it has been
planned for decades and was probably only months
away from commencing.
11 Sep 2010: Roads Service are
keeping their cards close to their chest in terms
of when this scheme might go ahead (see previous
update). However I note that they have just released
the initial tender for this scheme. This initial
tender is to allow interested engineering firms to
bid to be included in the more complicated tender
which could be released in a few month's time.
This two-stage process ensures that only those
firms who have a chance of winning the tender can
actually tender for it. This clue suggests that
construction may indeed be getting underway in the
near future.
21 Jun 2010: Over the past year
not much has happened on this scheme. A
geotechnical investigation was carried out in 2009
(exploring the type ground the road will be built
on) and an archaeological survey began at the end
of April, focusing on Castle Lug - the medieval
tower house that lies close to the Shore Road.
There has been speculation
in the media that the scheme is going to be
delayed. This has been confirmed to an extend by
Roads Service who are
now saying merely that "The start date
for this scheme will depend upon the
availability of funding in future years".
This effectively means that Roads Service no
longer knows when this scheme will be built. In a
debate
in the Assembly on 8th June, the DRD Minister said
"If the finances are available, delivery is
expected to start in 2011-12, and the project
should be completed in 2013." However this
seems increasingly unlikely to happen as the
financial situation deteriorates.
16 Jun 2009: The Regional
Development Minister provided an update
on this scheme in the Assembly on 5th June. The
Geotechnical Investigation (looking at ground
conditions on the proposed route) was carried out
from January to June 2009. Archaeological work is
due to be carried out during the Autumn of 2009.
The timescale has not really changed - subject to
the availability of funding (not a certainty these
days) it is planned to commence in 2010/11 and be
completed "by the end of the 2012/13 financial
year", ie by April 2013.
24 Nov 2008: The press release
issued 7 weeks ago (see previous update) suggested
that work would begin in 2010 or 11. When Roads
Service met with Carrickfergus Borough Council on
10 November this was revised to 2011 at the
earliest, as reported by The
Carrick Times. It quotes a Roads Service
spokesperson as saying that "With a fair wind,
construction will commence in 2011." and "We
are pushing this forward as vigorously as we
can; the slow bit has been the statutory
procedure, as a result of the objections we
received. Schemes compete and are subject to
availability of funding, but it is of the
highest priority within the eastern division." The
vesting order is due to be published during 2009
with the project put out to tender in 2010. This
will lead, if there are no problems, to work on
the ground commencing in 2011 and lasting about
two years.
2 Oct 2008: Roads Service's
response to the public inquiry was published on
30th September. It did not say anything earth
shattering, and committed to proceeding with the
scheme largely as proposed. The documents, available
here, outline Roads Service's response to
the main concerns of the inspector (of the public
inquiry). These include a slight realignment at
Langley Hall to avoid vesting land from properties
that were only constructed very recently and whose
location had received approval from Roads Service
at the time. It also modifies access to Belfast
High School which will now consist of a one-way
system accessed to and from the new road directly,
and the relocation of the pedestrian crossing.
However, a layby on the citybound carriageway has
been rejected on the grounds of safety and
cost/benefit analysis. The criticism that the
"online" nature of part of the scheme would not
allow for future road improvements on the road was
rejected by Roads Service on the grounds that no
specific improvements were currently proposed.
This viewpoint is in contrast to the approach
taken in the 1970s, when many roads were
constructed with additional capacity for future
improvements (eg M2 between j4 and j5). The
accompanying press release confirmed that work is
scheduled to get underway in 2010/11 and last
about two years.
22 Sep 2008: According to the Regional
Development Minister, the results of the
public inquiry into the scheme are expected to be
published in October 2008.
28 Apr 2008: According to the
strategy document "Investment
Delivery Plan for Roads" of April 2008, the
start date for this scheme has been pushed back
from 2008/09 to 2010/11 with completion due
2012/13. This delay is probably due to cash
shortages caused by the promotion of schemes on
the A5 and A6 corridors, but will be disappointing
new for Carrickfergus commuters.
17 Nov 2007: In this
press release from October 2007, the cost
was given as £55.2m. This is another
substantial rise in costs. The scheme was included
in the Draft Belfast Metropolitan Area Plan in
2004 at an estimated cost of £21m. By March
2006 the cost had been revised and had doubled to
£41m. The further rise of about 30% over the
past year and a half probably reflects refinements
in the design and rises in property values. In the
design currently proposed, Greenisland's medieval
tower hosue, known as Cloch-na-Larty will survive
the scheme but will lose some of the open land in
front of it.
Design of the New Road
The exact design of the road will depend on the
location. The "offline" section would see the road
built to rural dual-carriageway standard with a
total width of 27 metres. The "online" section
would reduce this to 22 metres to ease the impact
on properties. Local traffic will only be
permitted to turn left on and off the road except
for a few key junctions. People who wish to turn
right from driveways will turn left and then turn
round at the next junction. The junctions will all
be traffic-light-controlled roundabouts which
perform better than the more basic priority
roundabouts when the main flow of traffic is
"straight on". The road will have a 40mph speed
limit. Other options such as building the offline
option in a cutting to reduce noise were rejected
as they would require even more land.
Possibilities of building the road through the
grounds of the University of Ulster and through
the sea on a causeway were also rejected.
A person who lives on the route told me that the
Roads Service had in years gone by explored the
idea of building the road on the sea side by
reclaiming the beach, but that this idea was
abandoned after uproar from the residents. This
was tried in Whiteabbey, where the A2 was moved
onto the beach, and it has had a very negative
effect on the shoreline area. Widening the A2 through
Greenisland is also destructive, and so most of
the residents seem to prefer the inland option
which would re-route the road about 200 metres
inland and leave the Shore Road intact. The Public
Inquiry is likely to be a lively affair.
Photos

Part of the daily evening
traffic jam on the 2 lane section of the A2
approaching Greenisland. [Photo by Wesley
Johnston]
At the centre of the
village, the number of mature trees and large
houses close to the road is apparent. This picture
was taken in winter when the trees were bare, but
the road looks well in summer. [Photo by Wesley
Johnston]

The A2 running through the
centre of Greenisland village. [Photo by Wesley
Johnston]

Another
view of the A2, looking back to Belfast showing
the houses at the shore. More recent housing
developments, such as the one off frame to the
right, were built with the widening in mind, as
you can see from the wide grass verge. [Photo by
Wesley Johnston]
|
