|
|
Status
|
Construction scheme
(future) |
|
Scheme
|
New
high-quality dual-carriageway to replace
the existing single-carriageway A6 from
Dungiven to Derry; including a bypass
around the south side of Dungiven. |
|
Total
Length
|
30.0km / 18.8 miles
of which Dungiven Bypass section is 4.8km
/ 3.0 miles
|
|
Dates
|
Mar 2005 - Pilot study
to select route from Castledawson to Derry
announced.
Dec 2005 - Funding
announced to build section from Dungiven
to Derry.
Feb 2007 - Preliminary
route corridor selected.
May 2008 - Five route
options published.
6 May 2009 - Preferred
route announced.
14 Dec 2011 - Draft
legal documents published.
Jan 2012 - Public exhibitions.
24 Sep 2012 to 2 Oct
2012 - Public Inquiry held.
ca End Mar 2013 -
Inspector submitted Public Inquiry report.
Construction due after 2015 (as of Feb
2012).
Dungiven Bypass may be
built ahead of the main scheme (as of Mar
2011).
(changed from "after
2015" as of Jan 2011, and "early 2013" as
of Jul 2010).
|
|
Cost
|
£350m - £390m (as of Mar
2011)
or £60-80m for Dungiven Bypass section
only
(Changed from £320-390m
as of Dec 2009; £320m as of Dec 2008 £300m
as of Jun 2008 and £250 million as of
2005)
|
|
Photos
|
See below. |
|
See
Also
|

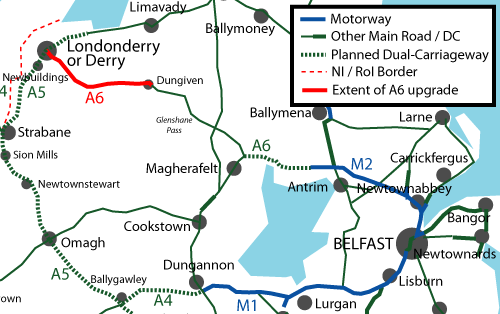

General
area map.
Roads
Service web site on scheme - very
detailed information including full
reports into Dungiven Bypass and rest of
scheme.
|
This major project was
announced on 13 December 2005 by the Northern
Ireland Secretary of State Peter Hain as part of a
larger investment package for the city of Derry.
It will see a dual-carriageway bypass of Dungiven
town and dualling of the existing A6 from there to
the A2 on the north-eastern periphery of Derry
city. The road will be build to a high quality
with two lanes each way, no breaks in the central
barrier and fully grade separated junctions (ie
flyovers). Plans announced in 2004 for a
single-carriageway bypass of Dungiven at a cost of
£11.1m have been subsumed by this much larger
scheme, although the preliminary work done will
still apply. As of 2008 the scheme was listed in
Roads Service's "preparation pool", meaning
commencement is anticipated "within 5 years". The
map below shows the section of the A6 affected by
this upgrade.

Route
The chosen
route closely follows the existing A6, except that
it bypasses Drumahoe well to the north at the
Derry end, and bypasses Dungiven to the south. In

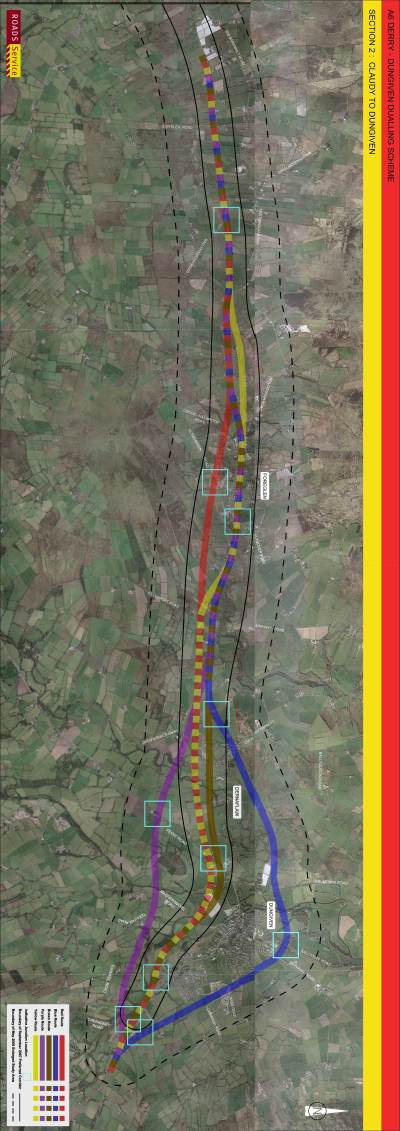

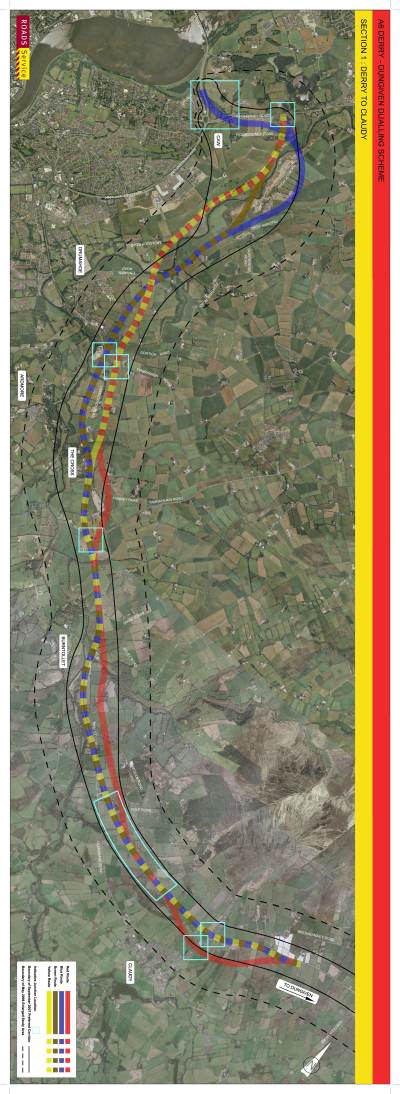

May 2009 Roads Service published maps showing the
chosen route. The maps are (as of May 2009)
available from the following links:
Roads Service have put an enormous
amount of information on their web site about this
scheme (see link at top of page). It includes the
2004 report into the single-carriageway Dungiven
Bypass then proposed. It also includes the 2007
report into dualling the entire A6 route from
Castledawson to Derry. The current scheme is based
on portions of both of these.
Strip Junction Map
This is a strip map of the design that was
published in May 2009. Note that the design may
change between this map and construction due to
the evolution of the design, and the public
inquiry.
|
WEST
Begins on A2
dual-carriageway, Derry
2+2 lanes
|
|
STRADREAGH
or GRANSHA
|
A2 Clooney
Road
(into Derry)
|
|
Local
access
A2
Clooney
Road
(to
Limavady)
|
|
5.3 km /
3.3 miles - 2+2 lanes
|
|

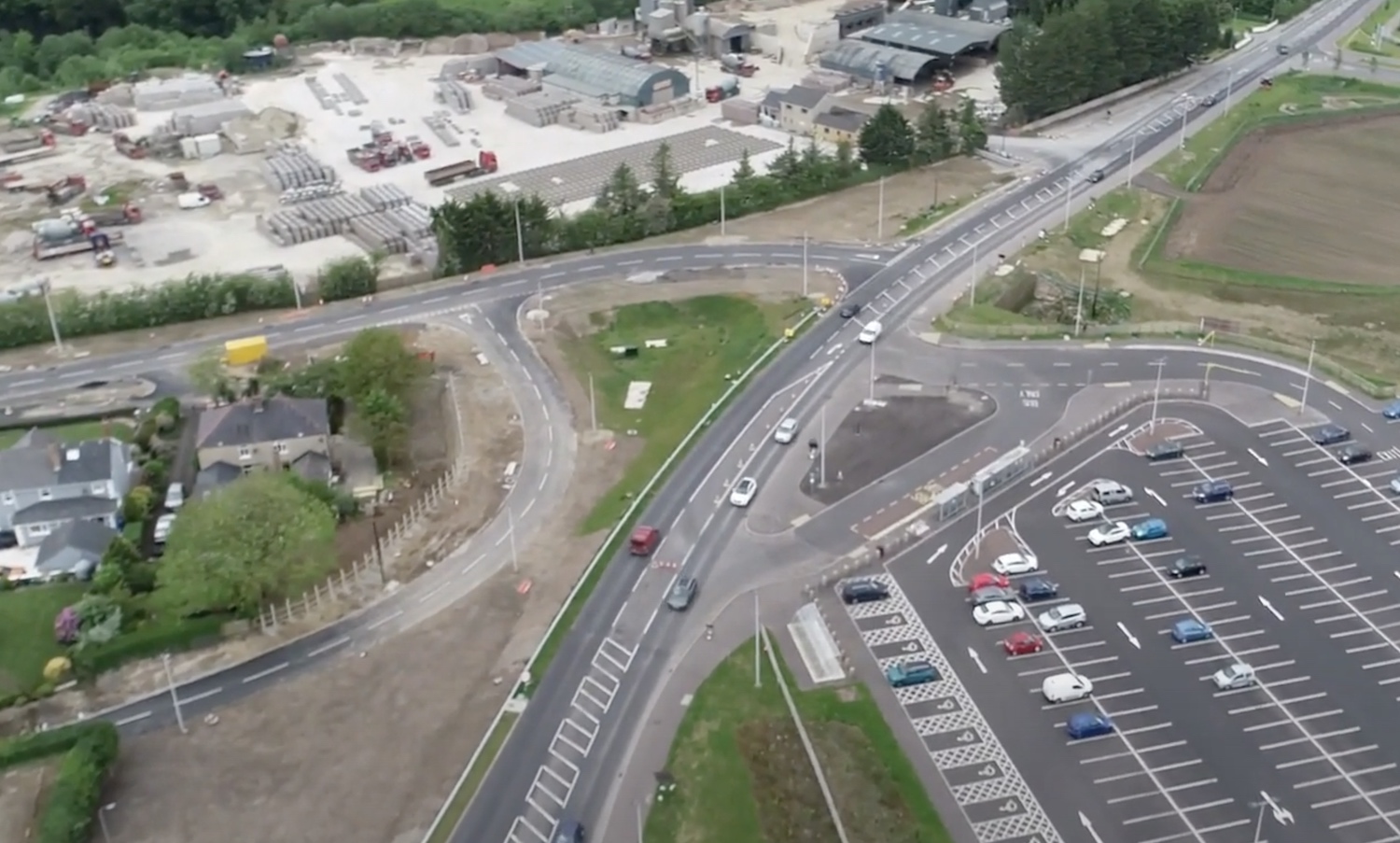

DRUMAHOE
|
B?
Glenshane
Road
(existing A6)
(into Derry).
|
|
Tirbracken
Road
|
| |
2.8 km / 1.7 miles - 2+2 lanes
|
|
TAMNAHERIN
or
THE CROSS
|
Local
access
Local
access
|
|
Tamnaherin
Road
|
|
2.0 km /
1.2 miles - 2+2 lanes
|
|
ARDMORE
ROAD
(BURNTOLLET)
Westbound access only.
|
Faughan
River
Ardmore Road
.
|
|
Burntollet
Bridge
.
|
| |
2.5 km / 1.6 miles - 2+2
lanes
|
|
KILLALOO

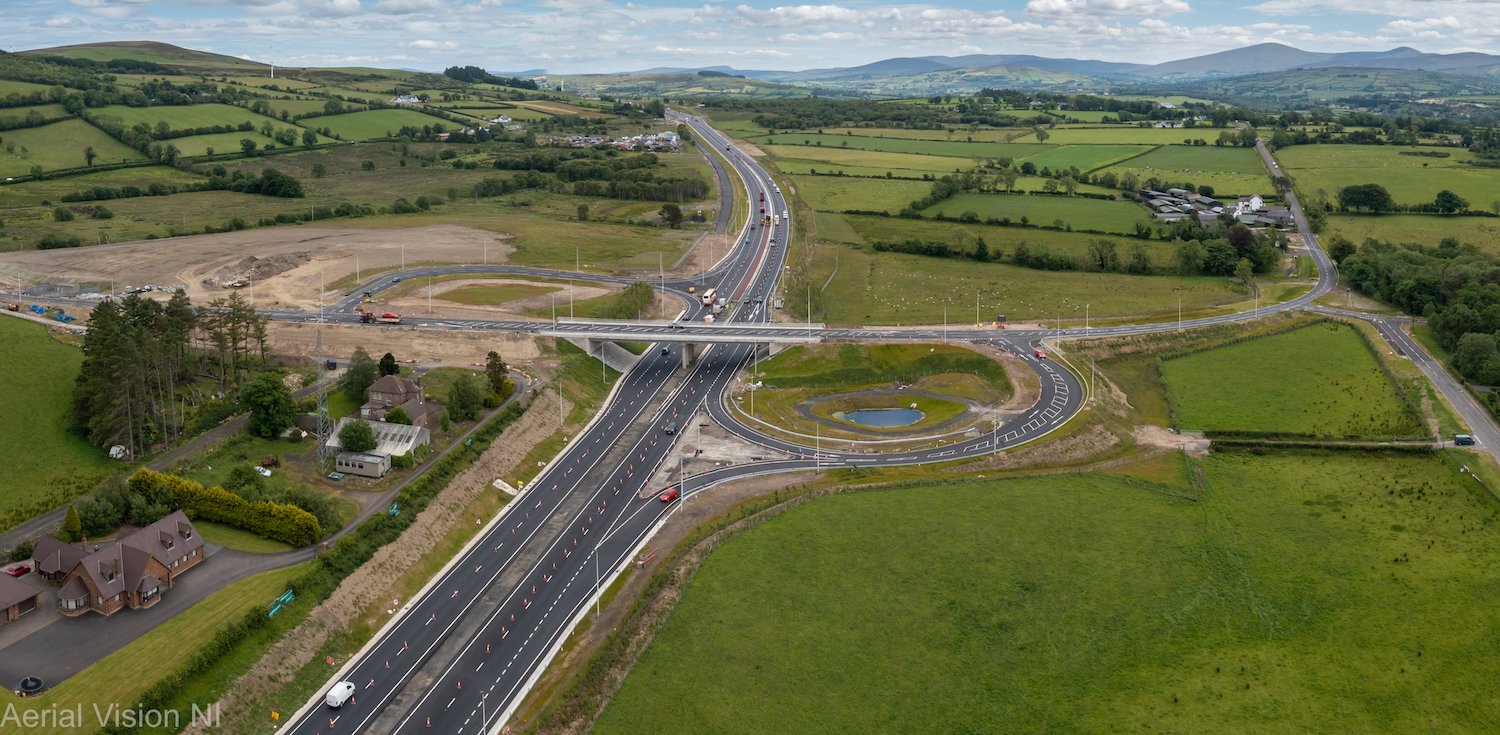

or
GULF ROAD
|
B74 Glenshane
Road
(Claudy west)
|
|
Gulf Road |
| |
2.5 km / 1.5 miles - 2+2 lanes
|
|

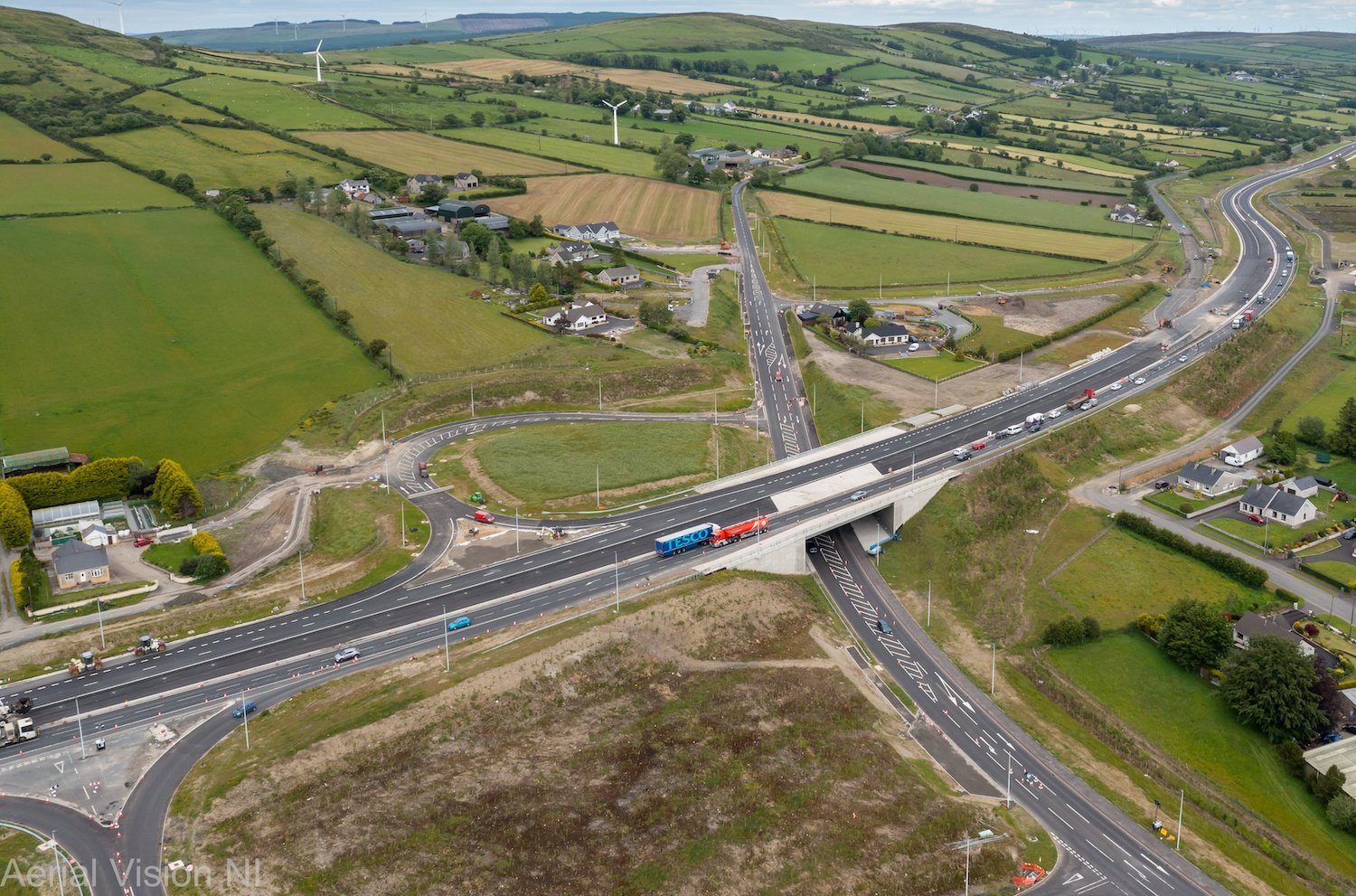

CLAUDY
or
BARANAILT ROAD
|
B69 Baranailt
Road (into
Claudy)
|
|
B69
Baranailt
Road
(towards
Limavady)
|
|
3.9 km /
2.4 miles - 2+2 lanes
|
|
BALLYHANEDIN
ROAD
This junction has been
dropped from the plans as of Dec 2011
|
|
|
Local
access
Ballyhanedin
Road
Local
access
|
| |
6.1 km / 3.8 miles - 2+2
lanes
|
|
KILLUNAGHT
ROAD
or
FOREGLEN
This junction has been dropped from
the plans as of Dec 2011
|
Killunaght Road
|
|
B?
(former A6)
(to
Foreglen)
B?
(former A6)
(to
Dungiven)
|
| |
3.0 km / 1.9 miles - 2+2 lanes
|
|
FEENY
ROAD
or
DUNGIVEN WEST
|
|
|
B74
Feeny
Road
(into
Dungiven)
|
|
2.5 km /
1.6 miles - 2+2 lanes
|
|
DUNGIVEN
EAST
|
|
|
B?
Glenshane
Road
(existing
A6;
into
Dungiven)
Local
access
|
| |
EAST
Terminates as
single-carriageway A6 towards Belfast
1 lane each way
|
Updates
1 May 2013: In my previous update I
commented that with the 12-18 month delay to the
A5 project, the "Dungiven Bypass" element of this
scheme must surely be high up the list of possible
alternative schemes to be progressed in the
meantime. In the Assembly
yesterday the Minister seemed favourable to
the idea when that precise question was put to
him. He said "I am pleased to confirm that the
design of the scheme allows for the Dungiven
bypass to be taken forward and completed as the
first phase of the scheme. It will provide 4·8
kilometres of dual carriageway bypassing
Dungiven to the south at a total cost in the
range of £60 million to £80 million. The
construction of this element of the scheme would
be dependent — and this is the key thing — on
the availability of finance in subsequent
periods." The last sentence is something he
'has to say' since the Executive has not yet
agreed how the A5 money will be reallocated, but
the first two sentences show that decoupling the
Bypass section from the larger scheme is a
distinct possibility. The main bit of work still
to be done is the analysis of the Inspector's
Report from last September's Public Inquiry which
has been received but not published.
15 Apr 2013: According to a Question
for Written Answer in the Assembly, the DRD
Minister has now received the report from the
Inspector at last September's Public Inquiry. This
is almost exactly to the timescale predicted at
the end of the Inquiry (see update below for 4
Oct) which is nice. The report will not be
published just yet. Typically, the DRD take a few
months to examine it and respond to any
recommendations before publishing both the
inspector's report and their response (called a
"Departmental Statement") simultaneously. We could
expect to see this before the end of 2013. Given
the recent delays on the A5 project, the "Dungiven
Bypass" element of this scheme (a small but
critical part of the whole scheme) is surely high
up on the list of possible schemes to be taken
forward at an earlier date, so it is very timely
that the Public Inquiry report has been received.
Let us hope that there were not too many issues
with the plans.
24 Oct 2012: For those with a particular
interest in this scheme, Roads Service have just
published transcripts of the six day Public
Inquiry that took place a month ago. You can download
them here. This is only the third time that
I know of that Roads Service have published such
transcripts (the first two being for the A55 at
Knock and the A5 WTC) and is a very welcome
development for public transparency. Happy
reading!
4 Oct 2012: The Public Inquiry into this
scheme took place as planned from 24th September
to 2nd October, and finished on schedule having
heard over 125 objections. The Inspector, JA Robb,
will finish by conducting site visits on 9th and
10th October. The DRD say that they expect the
Inspector to submit his report "before the end of
March 2013", but it is important to note that it
will not be published at that point. The DRD
typically take a few months more to consider the
recommendations and outline their response before
publishing it. So we might expect to see it around
the summer time next year. Detailed information
about the objections, along with transcripts of
the Public Inquiry are (or soon will be) available
here. With thanks to Paul McCloskey. Some
(including me!) are speculating that the
unexpected delays to the A5 scheme over the past
month might free up some money over the coming
months that could potentially be redirected to the
Dungiven Bypass element of this scheme. This is
quite possible, since the Minister has already indicated
that he is sympathetic to the idea of proceeding
with the Dungiven Bypass ahead of the rest of the
scheme. Watch this space.
26 Jun 2012:
We now
know that the Public Inquiry into this
scheme will begin at 10am on 24 September 2012, in
the Roe Park Hotel, 40 Drumrane Road, Limavady
BT49 9LB. The Inspector will be JA Robb, who was
also the Inspector for the A8 Larne Public Inquiry
and the A6 Castledawson-Randalstown dualling
Public Inquiry. Roads Service has also published
their pre-Inquiry Departmental
Statement, which sets out in considerable
detail their case for building the road as
proposed. This contains some interesting
historical information and is worth a read for
that reason alone. In another interesting
development, speaking
in the Assembly yesterday the DRD Minister
gave a strong hint that the Dungiven Bypass
section may be decoupled from the rest of the
scheme and built separately. They had previously
resisted this as it was anticipated that the
entire A6 scheme would proceed before too long,
and hence there was little to gain by dealing with
Dungiven separately. However, as it now seems as
if it could be some years before the scheme is
built, there would now be merit in building the
Dungiven Bypass scheme separately (see update
below for 14 Feb 2012). The Minister said: "I can confirm that
it will be possible to bring forward the draft
statutory Orders for the construction of the
bypass at Dungiven ahead of and without
compromising the future delivery of the
remainder of that scheme. However, this is, of
course, all conditional on available funding."
This is interesting news.
24 Jun 2012: The
DRD Minister has announced
that (not surprisingly) a Public Inquiry will be
held into this scheme, since it attracted 122
objections during the consultation period between
December 2011 and March 2012. The Inquiry will
probably be held in late September, and further
details are due to be released this week. This is
later than anticipated last summer, but still
welcome. There is currently no financial
commitment to actually build the scheme, but it is
important to keep progressing the scheme so that
it is 'good to go' if and when money becomes
available.
14 Feb 2012:
Today saw a major
announcement of how the money for roads will
be spent over the next four years. This scheme was
not among them. This was not surprising, but until
now we have had at least hoped that it might begin
around 2014/15 (see update below for 11 May 2011).
Today's announcement means it won't commence until
at least 2015. However, it is disappointing that
the Minister has not at least chosen to press
ahead with the Dungiven Bypass element of the
scheme. Dungiven is the only town not bypassed on
the entire A6, and all the traffic pollutes the
village. However, it should be said in the
Minister's defense that the scheme has not yet had
its public inquiry, and this means even the
Dungiven Bypass could not commence for at least a
couple of years, even if it was decided to go
ahead with it separately. The money that is
available needs to be spent sooner than that
timescale would allow.
8 Jan 2012: Roads
Service will be holding the next round of public
exhibitions into this scheme this month. As
always, I would urge anyone with an interest in
the scheme to turn up as this is a vital part of
the process, and an opportunity to express your
views. According to this
press release, issued just before Christmas,
the exhibition dates are:
- 17 and 18 Jan 2012 - Dungiven Sports Pavilion,
Chapel Road - 10am to 9pm
- 24 and 25 Jan 2012 - YMCA, 51 Glenshane Road,
Drumahoe - 10am to 9pm
- 26 Jan 2012 - Strathfoyle Youth Centre, 13
Deramore Drive - 10am to 9pm
The deadline for comments and objections is 2
March 2012.
For those interested in history, this
scheme page now contains links to multiple
historical documents.
17 Dec 2011:
The draft legal orders for this scheme were
published on 14th December. These include the Environmental
Statement (sets out what impact the scheme
will have on society and the environment and is
required by law). It also includes the draft legal
order (required to build a new trunk road)
and the vesting orders, part
1 and part
2 (which define whose land they will be
buying to build the road) and some other
documents. The Environmental Statement includes
revised plans for the junction, which are
interesting in that two junctions have been dropped entirely
- which is excellent news as they merely provided
superfluous links across to the existing A6 which
will remain in place as a perfectly adequate route
(presumably with a 60mph speed limit) for
accessing all the properties along that stretch.
The changes made since we were last given junction
designs in May 2009 are as follows:
- The layout of Killaloo junction west of Claudy
has been amended slightly - I have altered the
strip map above to reflect the new design.
- Ballyhanedin Road junction east of Claudy has
been dropped - the road will be bridged over the
A6 but with no access to the A6.
- Killunaght Road junction near Foreglen has
been dropped - the road will be bridged over the
A6 but with no access to the A6.
4 Jul 2011: The Minister has confirmed
that the draft legal documents required to build
the road will be published "later this year", and
that the Public Inquiry will likely be held in
Spring 2012, slightly later than expected in
April. This does not imply that the road will go
ahead any earlier than previously stated, merely
that Roads Service want to press ahead with the
process so that, subject to the Inquiry,
construction of the road can go ahead once finance
is available.
14 May 2011: Speaking at the
Annual Dinner of the Chartered Institution of
Highway Enginners Northern Ireland, the Permanent
Secretary of the Department for Regional
Development Malcolm McKibbin said "development
work is proceeding on the A6 schemes and late
changes to the draft budget mean that we should
also be able to start construction in the last
year of the budget period" (quoted in Plant
& Civil Engineer, May 2011). There are two "A6
schemes" - this one, and the scheme to dual the A6
from Randalstown to Castledawson. The Minister's
comments last month about Dungiven (see previous
update) suggest that Mr McKibbin may be referring
specifically to this scheme when he says that
construction should be able to start, but it's
possible he means both. Previously both schemes
were delayed until at least 2015. The "last year
of the budget period" is the financial year
running from April 2014 to April 2015.
27 Apr 2011: The Minister has
confirmed in a Written
Answer that development work will proceed on
this scheme over the next few years, despite there
not being enough money to build it. In particular,
he suggests that the draft legal documents
required to build the road will be released in
late 2011, and that the Public Inquiry is likely
to take place in "late 2011/early 2012" - somewhat
later than was anticipated last Autumn. He also
implies again that the 2.5km Dungiven Bypass may
be built ahead of the main scheme. The cost is now
being given as "£350m-£390m", slightly
higher than the figure of "£320-£390m"
being quoted in late 2009.
7 Mar 2011: Roads Service have
come into some new money, to the tune of £107m,
and this
press release suggests that some of it may
be put towards the A6. The Minister does not say
which of the two A6 schemes it refers to
(Randalstown to Castledawson or Derry to
Dungiven), but his comment that "the Dungiven
Bypass will be the priority" suggests it is this
scheme. The money is nowhere near enough to
complete this entire scheme, so it is possible
that the 2.5km Dungiven Bypass section may proceed
before the rest of the scheme - but this is not
stated, so we don't know. Dungiven is singled out
because it is now the only town on the entire
Belfast to Derry route that is not bypassed.
14 Jan 2011: Roads Service have
revealed their budget for 2011-2015 and, due
to lack of money, this scheme has now been put on
hold, seemingly until at least 2015. The only note
is that funding will be available to "continue
development" of the project, but not
actually build it. In the reduced funding climate
all available monies are being funnelled into the
A5 and A8 schemes.
19 Oct 2010: In a Written
Answer in the Assembly, the Minister has
said that the legal documents that are required
(see update below on 16 Feb) will be published in
early 2011, which represents a bit of slippage on
the dates given earlier this year. The estimated
date of the Public Inquiry is now being given as
"summer 2011". Assuming the public inquiry passes
the scheme, and subject to the availability of
finance, the Minister is saying that work should
begin in 2013. Due to the inevitable budget cuts
in the coming months, the Minister for Finance has
asked all other Ministers to suggest how their
budgets could be cut. However the Minister for
Regional Development is currently reluctant to
suggest places were cuts could be made in his
department, which makes it impossible to assess
whether or not the 2013 date is realistic.
Hopefully the situation will become clearer in the
near future once firm decisions have been made. A
number of "Health Impact Assessment" workshops
were held in late September, and details can be
found on the Roads Service web
site. It's not immediately clear from the
material on the web site what material impact this
will have on the scheme.
18 Aug 2010: In a briefing
to Derry City Council in July, Roads Service have
said that work on this scheme is still expected to
begin in "early 2013". However, we should not rely
too much on this since the important budget
decisions due to be taken in the coming months are
likely to impact on roads.
16 Feb 2010: According to the
Minister in the Assembly
on 8 Feb 2010, design work is continuing and Roads
Service hope to publish the draft Direction Order
(basically the legal document giving permission to
build a new main road) and the draft Vesting Order
(the legal document needed to buy the land to
build the road) "before the end of of 2010". The
cost was re-stated, and has not changed, at
£320m-£390m.
18 Jan 2010: The terminus of the
new road at the Derry end will require changes to
the A2 Clooney Road, mainly involving improving
the alignment and standard, and removing one
roundabout. A public exhibition of what is
proposed will take place at The North West
Teachers Centre, 24 Temple Road,
Strathfoyle on Tuesday 19th January 5pm-9pm and
Wednesday 20th January 1pm-9pm. I would encourage
all those with an interest in the scheme to turn
up as this is one of the main ways that the public
can engage with the planners.
7 Jan 2010: According to a Written
Answer in the Assembly in late December
2009, the current estimate of the cost of this
scheme has risen to "£320m to £390m" which is a
further increase on the "£320m" estimated in
December 2008.
6 May 2009: The Minister
announced the
preferred route today. The new road will be
built to dual-two lane standard, with 1 metre hard
strips and no central reserve crossings. Starting
at a new roundabout east of Dungiven, it will
bypass Dungiven to the south before following an
offline route for the first 10km. It will then
join the existing A6 where it will be an online
upgrade past Claudy until close to Drumahoe. It
then heads cross country again to the north to
join the existing A2 road at a new roundabout at
Gransha. This is quite far north, so we could
expect a large percentage of motorists will elect
to leave the road at Drumahoe and use the existing
A6 past Altnagelvin rather than go all the way up
to Gransha. All seven intermediate junctions will
be grade separated - six with a "compact" design
and one (Drumahoe) with a larger layout. There may
also be a westbound left-in/left-out junction at
Burntollet, but the Road Service map is not clear
enough to determine if this is true. I have put an
approximate version of the route
onto a Google Maps overlay, seen by clicking
here. The press are reporting that
construction will start in 2012 and last until
2016, but this is not stated in the Roads Service
material. The official position late last year was
construction commencing in 2013 subject to the
availability of funding.
27 April 2009:
Roads Service have said that the
preferred route will be announced in early May,
and details will be on display to the public at
the following locations and dates:
- 6 & 7 May 2009: Dungiven
Community Hall, Chapel Road, Dungiven,
1pm to 9pm
- 12 & 13 May 2009: YMCA
Centre, 51 Glenshane Road, Drumahoe,
1pm to 9pm
All those with an interest
in the scheme should be urged to turn up, as this
is one of the key meetings to have your questions
answered and raise any concerns. Representatives
from Roads Service and the design company will be
there.
16 Dec 2008: According to a Stormont
Assembly written answer last week, the
estimated cost of the scheme has now risen to
£320m. It confirms that the preferred route is due
to be announced in the Spring of 2009 and again
tentatively suggests commencement may be around
2012/13.
10 Dec 2008: Roads Service
published a
4-page leaflet on the scheme last month. It
does not contain any new information, but confirms
the timescale previously announced and provides a
useful summary of the scheme.
21 Oct 2008: According to an Assembly
written answer from 17 October, the scheme
is still on schedule for commencement "during the
2012/13 financial year". The answer also states
that the Dungiven Bypass portion of the scheme
will take about 18 months to complete. There have
been hints that this part of the scheme may
progress early on in the scheme to ensure that it
is open as soon as possible.
15 Jun 2008: According to this
press release, the cost of the project has
risen to £300m (up from £250m estimated in 2005).
It also revealed that the preferred route is due
to be announced in the summer of 2009 and that
"over 100 people" are involved in the route
development in one form or another. The press
release has also said that Roads Service are now
investigating how to provide a link from the A6 at
Drumahoe to the A5 on the south side of the city.
Such a link would almost certainly follow a new
offline route. It is unclear if this link would be
part of this scheme, or be a separate project.
24 May 2008: Roads Service are
holding a series of public exhibitions between 20
and 28 May. They are using these to reveal the
five chosen route corridors. Interestingly, some
of these stray OUTSIDE the route corridor
announced last year and thus there is now an
"expanded" route corridor. At the Derry end it now
looks almost certain that the road will tie in to
the existing A2 between Caw and Maydown rather
than the Crescent Link itself. At the Dungiven end
two new routes for the bypass of the town are
being considered, after complaints about the
current route that will sever a GAA training
ground. One of these passes further to the south,
beyond the river, while the other passes to the
north of the town. All the documents made
available on the days are also online
here, including more detailed versions of
the above maps.
28 Apr 2008: The publication in
April 2008 of the "Investment
Delivery Plan for Roads" document has
allayed fears that the scheme will be
delayed, since it includes this scheme in the
"Preparation pool" which contains schemes
anticipated to begin within 5 years, ie by 2013.
8 Mar 2008: According to Roads
Service, ground surveys on the chosen route
corridor are underway. This will inform the
decision on a preferred route within this
corridor. Roads Service still have the scheme in
their "preparation pool" (construction anticipated
within 5 years or so) but with the recent
announcements by Conor Murphy (see previous
updates) it's still unclear what the timescale is.
5 Feb 2008: Conor Murphy has
again denied that there is any slippage in
the timetable for the project. He said that "it
is not correct to state that there has been
slippage on the A6 Derry to Dungiven project.
Indeed in July 2007 I announced the appointment
of consultants to examine options to enable the
selection of a preferred route by spring 2009".
There is no doubt that this is true, but it only
refers to the first element of the project. The
"slippage" being noted is in the timescale for
completion of the project as a whole. When first
announced,Roads Service were saying that the
scheme would be delivered within the timetable of
the Regional Strategic Transport Plan which ran
from 2005-2015. Now, they are saying that it's
going to be delivered within the timetable of the
Investment Strategy 2008-2018. While it's only a
time period, it still has the potential
to delay the project by up to three years.
30 Dec 2007: Conor Murphy responded
to the media reports last week by assuring
business leaders that the scheme has NOT been
cancelled and will proceed. However, while
reassuring, his statement does seem to be a
disguised attempt to sneak a revised timescale
through. When the scheme was first announced in
2005, it was stated that it would be built within
the timescale of the Regional Strategic
Transportation Network Transport Plan 2015, ie by
2015. However in this week's statement, Conor
Murphy now says that it will be built within the
timescale of the draft Investment Strategy
2008-2018, ie by 2018. This subtle change means
that the project could potentially be delayed by
up to three years. This would seem inevitable give
the level of financial committment required for
the A5 dualling scheme.
24 Dec 2007: As has been noted
by the media, this scheme is mysteriously
missing from the Draft Investment Strategy
2008-2018 which was published in October. This
Strategy (admittedly a draft) outlines the targets
of spending of £3bn on roads over the next ten
years. Under its list of "key milestones" it lists
the A4 dualling scheme (Dungannon to Ballygawley),
completion of the A1 dualling, completion of the
M1, M2 and Westlink upgrades, the recently
announced A5
dualling scheme (Londonderry to Aughnacloy)
and the A8
dualling scheme (to Larne). However there is
no mention of the A6 dualling scheme. According to
Derry Chamber of Commerce, the DRD has said that
the A6 scheme may be put on hold or delayed. This
is speculation, but it is worth
noting that the shortfall required in order to
undertake the A5 dualling scheme is £260m. This is
almost the same amount as the cost of this scheme.
So it is possible that the Regional Development
Minister Conor Murphy has decided to take the
money from this scheme and use it to fund the A5
scheme instead. If so, and it is only guesswork,
then it is likely to prompt a lot of debate on the
subject.
Background to Scheme
The Regional Strategic Transport Plan, published
in 2004, explained why it was thought that further
dualling of the 40km of the A6 beyond Castledawson
could not go ahead before 2015:
B3.3.41 When the funding envisaged by RTS
is extended to 2015, there would be £529.4m
available for Strategic Road Improvements in
the RSTN TP period. However, this is fully
taken up by the high priority SRIs proposed
across the RSTN, including the £171.9m
envisaged for SRI schemes on routes serving
the North-West. Therefore, within the funding
assumptions of this Plan, it would not be
realistic to expect that further dualling of
the A6 could be undertaken within the Plan
period (apart from the Randalstown to
Castledawson section already proposed).
B3.3.42 However, further dualling of the A6
will be required outside the RSTN Plan period,
in order to develop and upgrade the link
between Northern Ireland’s two largest cities
by 2025. Therefore, during the Plan period it
will be necessary to plan the route of a dual
carriageway between Castledawson and Derry, by
undertaking a route selection study. This will
inform the decision regarding the acquisition
of land and route protection lines, e.g. for
the Dungiven Bypass.
This lack of funding
was rectified suddenly and somewhat unexpectedly
in December 2005 by the announcement of sufficient
funding for the Dungiven to Derry section.
Prophetically, the RSTN did comment that "It
is... likely that future dualling in the 2015 to
2025 period will commence at the Londonderry end
of the route." This is because traffic
levels are highest at the Toome and Derry ends of
the A6, and lowest at the Glenshane Pass and
because of the difficult terrain crossing the
Sperrins. Traffic figures collected in 2004 showed
the following daily traffic at various points on
the A6:
- Toome - 21160 vehicles
- Castledawson - 14880 vehicles
- Ranaghan (Glenshane Pass) - 10470 vehicles
- Western edge of Dungiven - 13820 vehicles
- Altnagelvin, Londonderry - 12930 vehicles
- Rossdowney, Londonderry - 26930 vehicles
Thanks to Diarmaid Elder for the traffic
information on this page.
Photos

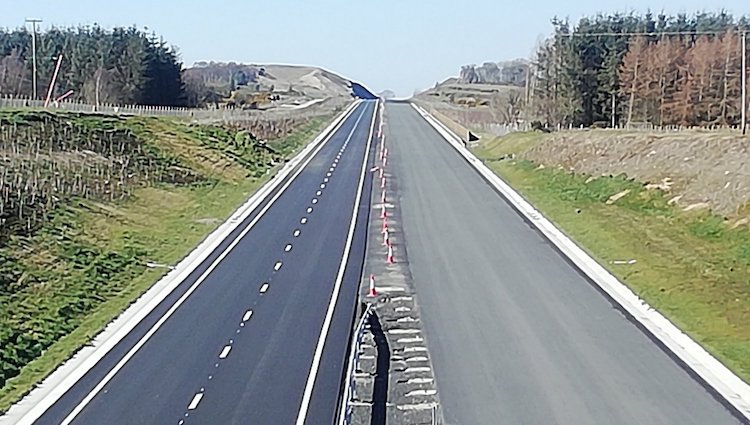

A typical view of the A6
road in its current form, here seen near Dungiven.
[Photo by Wesley Johnston]
Dungiven town centre is
the biggest bottleneck on the route, and will get
a bypass. [Photo by Wesley Johnston]
Lots more photos of the
road are available on the Roads Service web site -
see link at the top of this page.
|
