|
|
Status
|
Construction scheme
(current)
Contractor: PT McWilliams and McLaughlin
& Harvey joint venture
|
|
Where
|
To link the
north and east of Enniskillen, bypassing the
town centre. |
|
Total
Length
|
1.5km / 0.9 miles
|
|
Dates
|
Scheme included in RSTN
plan 2003
Environment Impact
Assessment prepared 2005
Preferred route option
selected 2007
12 months of advanced
site preparation work began Feb 2010.
Tender due to be
released Dec 2010 (as of Oct 2009)
Work began 26 Sep 2011
Work to be completed by
April 2013 at latest (as of July 2011)
(Formerly due to
commence on site "during 2010" as of May
2009)
|
|
Cost
|
£12.85m
- as of Sep 2011
(revised
rom £11m as of Mar 2009, itself
revised from £8m as of Dec 2006,
itself revised from £3.8m quoted
in the Sub-Regional Transportation Plan
published in 2006)
|
|

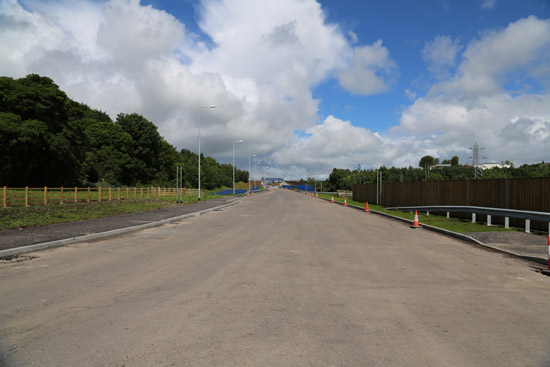

Photos
|
None as yet - please
contact me if you have any to contribute.
|
|
See
Also
|
General
area map
Route
map - this Roads Service PDF file
has a route map
(See also map below)
A4
Enniskillen Southern Bypass (on this
site)
|
Enniskillen is a busy town because it is the
crossing point of a number of main routes, most
notably the A4 Belfast to Sligo route but also the
A32 route north to Irvinestown. As the town lacks
any bypasses (other than the Enniskillen
Throughpass running parallel to the town centre)
strategic traffic has to mingle with local traffic
in the town. This scheme will allow traffic to
move between the A4 east of the town and the A32
to the north without having to go close to the
town centre.

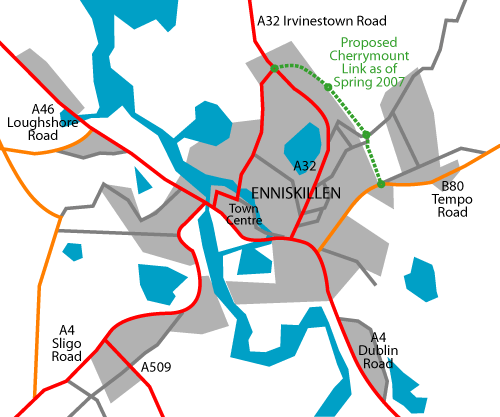

It consists of a 2.0km link road running from the
existing Cherrymount roundabout on the A32 to the
B80 Tempo Road. Traffic will then use the existing
B80 to reach the A4 road. (This part of the B80 is
likely to be re-numbered as A32.) The northern
0.5km already exists, but will be upgraded. The

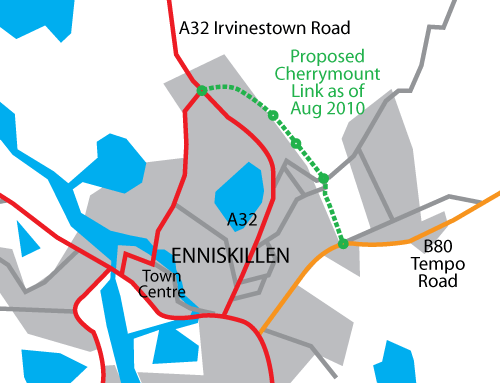

map below (not to scale) illustrates the proposals

and shows the locations of the four new
roundabouts that form part of the plan as well as
the existing roundabout on the A32. This means
that the completed road will end up with five
roundabouts in the space of just 2km, enough to
frustrate any motorist! A more detailed map
can be seen in this
Roads Service document published in July
2010.
(Map based on Google Earth imagery).
The road will be build to 2 lane single
carriageway standard (one lane each way) and will
very likely include at least one footway and
cycleway. Roads Service estimated in this
press release that the new road will attract
around 9,000 vehicles per day.
The Cherrymount Link scheme was first included in
the 2003 Regional Strategic Transport Network
Plan. However, the scheme as currently proposed
(as of August 2010) follows a slightly different
route than originally proposed. This new route,
which runs a few hundred metres further east in
the central stretch, "made use of better
ground conditions and took advantage of
anticipated reduced land purchase costs".
Progress
17 Dec 2011:
I've been contacted by someone who is working on
this scheme, and he has clarified a couple of
matters. Firstly, the scheme involves 1.5km of new
road, (not 1.1km as I had been stating) along with
an upgrade to 0.5km of the existing link road at
the north end of the scheme. Secondly, the long
duration of the scheme (see previous update) is
due to "2
sections of ground improvements... these
sections involve poor ground conditions with
peat and alluvium up to 10m in depth. There are
several other contractor design elements
including retaining walls, strengthened
earthworks and foot bridge design (2 no.)".
The scheme has now been underway for three months,
and to date work appears to have concentrated on
preparing the boggy ground. I have not named the
contributor as they are presumably working on the
scheme, but thank you!
21 Sep 2011:
Much rejoicing can be heard in Enniskillen this
week because work on this scheme is finally, finally,
starting on Monday 26th September. The Minister
issued a press
release last week revealing that the
successful contractor is a joint venture between PT McWilliams and
McLaughlin & Harvey. The same press
release confirmed that the total cost of the
scheme is £12.85m, of which the cost of the
actual construction work is £5.46m.
Completion is due "by Spring 2013", ie about a
year and a half from now, which is a surprisingly
long time to build 0.7 miles of single carriageway
road. But perhaps we should not quibble, given how
long this scheme has been in the pipeline.
4 Jul 2011: In a Written
Answer in the Assembly two weeks ago, the
Minister said that the deadline for contractors to
submit tenders to construct Cherrymount Link was
16th June and that the tender is due to be awarded
in September "to facilitate the completion of
works before the end of the 2012/13 financial
year". In the current financial climate the
contractor will be keen to begin work as soon as
possible, so we're looking at a probable start
date for the work of this coming Autumn.
According to the dates given, the latest
completion date would be April 2013, which
suggests a maximum construction period of 19
months, possibly less.
14 Jan 2011: Supporters of this
scheme should consider themselves lucky today. In
the draft
DRD budget released yesterday, Cherrymount
Link is the only scheme other
than the major A5 and A8 schemes to have survived
a big cost-cutting exercise. All other strategic
schemes in the province have been delayed until at
least 2015, with Cherrymount Link being the only
one that is still expected to continue as planned.
Construction is currently scheduled to begin this
year.
11 Sep 2010: Roads Service have
released the initial
tender for this scheme. This initial tender
is to allow interested engineering firms to bid to
be included in the more complicated tender which
should be released in a few month's time. This
two-stage process ensures that only those firms
who have a chance of winning the tender can
actually tender for it. Neverthless, this means
that the ball is rolling and construction appears
to be creeping closer.
10 Aug 2010: Roads Service have
released an updated
leaflet and map of the scheme. This shows
that a fourth new roundabout has been added to the
central portion of the scheme to serve future
developments. Taken together with the existing
roundabout on the A32 Irvinestown Road, it seems
that the new road will require motorists to
negotiate five roundabouts in the space
of just 1.1km, which is surely enough to frustrate
any motorist!!
7 June 2010: Last December the
Minister was only able to say that the Cherrymount
Link "could" start in 2011. This now seems more
certain, because in this
press release from three days ago the
Minister said "It is... anticipated that the
ground consolidation measures taking effect at
Cherrymount Link, Enniskillen, will be followed
by the main construction works next year".
This will be encouraging for the people of
Enniskillen.
21 Apr 2010: The cost estimate
for the scheme has risen again. According to
updated information on the Roads Service web site,
the scheme is now estimated to cost £12-16m,
an increase on the £11m being quoted until
recently. The main construction contract is still
scheduled to be put out to tender in December
2010, so we could see construction begin later in
2011 or early 2012.
16 Feb 2010: According to an
article in the Fermanagh
Herald, contractors have begun work
preparing the ground along the route of the new
road by infilling the soft, waterlogged land. This
job will take about 12 months, and so it has begun
now so that it is completed by the time
construction on the actual road begins, currently
estimated to be sometime in 2011. For clarity,
this does NOT mark the commencement of
construction of the new road itself, since this is
an entirely separate contract. Construction of the
road is currently waiting for the approval of
funding, the timing of which is uncertain in the
current financial climate. However, the work that
has begun does strongly reassure the people of
Enniskillen that Roads Service are committed to
proceeding with the scheme. The article also notes

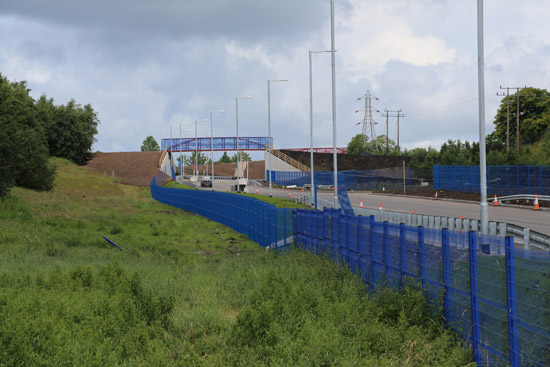

that the scheme will include two footbridges - one
near Coa Road, and another to give access to the
playing fields of St Michael's College.
4 Dec 2009: In one
of these Written Answers, the Minister of
Regional Development has confirmed what we
suspected in October, namely that construction has
got pushed back into 2011. The Minister said "My
Department’s Roads Service remains committed to
the completion of this worthwhile project. The
land required for the construction of the
Cherrymount Link Road has been acquired, and
construction work could start in 2011,
subject to the level of funding available at
that time." Even this statement is
non-committal, and suggests that funding pressures
are starting to show. Understandably, the local
media is
not impressed. Roads Service have also said
that the land for the scheme has now been fully
acquired.
18 Oct 2009: This scheme has
appeared on the "future contracts" section
of the Roads Service web site, and the news is not
good in terms of timescale. Although Roads Service
said in June that the scheme would hopefully get
underway "during 2010" according to the tender
information the tender is not even due to be
released until December 2010, meaning that work
will not begin until 2011 at the earliest.
Interestingly, the tender says that there will be
500 metres of "single lane dualling" (ie one lane
each way with a central barrier) and two
footbridges. The contract duration has now been
given as "30 months", ie 2.5 years. If this means
the time it will take to construct the road, then
it seems an awfully long time for such a small
scheme. By this timetable the earliest we can
expect completion of the road is mid 2013.
8 June 2009: At a meeting
with Fermanagh District Council two weeks ago,
Roads Service said that the Environmental
Statement, Notice to Proceed with a Direction
Order, and Vesting Order were published in March.
They also said that the intention is to commence
on the ground during 2010.
9 Mar 2009: The last time we
were given an estimate of the cost of this scheme
was in December 2006, when the cost was given as
£8m. The DRD Minister has
now updated this, and the new figure is
£11m. This is likely due to the development
of the design which tends to add new elements.
24 Feb 2009: Roads Service
published their notice
of intention to proceed with the scheme two
weeks ago. The document gives a summary of the
scheme, the environmental impact, and an outline
of the process that was taken to arrive at the
final proposal. The document states that the
nothernmost 500 metres will be a single-lane
dual-carriageway (ie one lane each way separated
by a barrier) which is quite an unusual, but also
very safe, design that eliminates accidents
associated with right turns. Although information
in April 2008 was that work would commence in
"2008/09", this has now been pushed back a bit.
According to the Roads
Service report to Fermanagh District Council
in November 2008, the land will be purchased by
April 2009 and "It is hoped that an advanced
earthworks contract can then commence on site
during 2009/10." The final cost is also
unclear, since the last published estimate of
£8m was in 2006.
27 Jun 2008: As suspected, this
Legal
Order has been passed which will make the
Cherrymount Link part of the A32. The part of the
B80 Tempo Road that runs from the planned
Cherrymount Link to the A4 Dublin Road will also
be part of the A32. What will happen to the
existing stretch of the A32 Irvinestown Road that
will be bypassed by the Cherrymount Link is
unclear, but it will likely be downgraded to a
B-road once the new road is opened.
28 Apr 2008: According to the
Investment Delivery Strategy for Roads of April
2008, the scheme is set to commence in "2008/09"
with completion due in "2009/10".
4 Nov 2007: A public display of
the selected route will take place in Erne
Integrated College on 5th November. The timescale
for commencement of construction is now slightly
more specific with work due to begin in either the
2008/09 or 2009/10 financial years depending on
how quickly the statutory processes are concluded.
14 Feb 2007: At a meeting
between Fermanagh Council and the Roads Service on
6 December 2006, it was revealed that construction
has been pushed well back from the April
2007-April 2008 slot claimed by Roads Service in
2006. They are now anticipating construction in
the period 2010-2011. Also, they have revised the
cost up from £3.8m to £8m which has
been attributed to extending the scheme,
undertaking widening work and increases in land
value. The council has expressed its disapproval
at the timescale of the whole project from
planning to completion, currently said to be
2007-2011.
15 Nov 2006:
According to this
Parliamentary written answer, dating from March
2006, work is anticipated to begin in the 2007/08
financial year, which means between April 2007 and
April 2008.
|
