|
|
Status
|
Construction scheme
(future) |
|
Where
|
To
complete the dualling of the Belfast to
Larne road by filling in the remaining
stretch from Coleman's Corner near
Ballyclare to the B100 Ballyrickard Road
at Ballyedward, south of Larne. |
|
Total
Length
|
13.7km / 8.6 miles |
|
Dates
|
Mar 07 - Suggestions
that the Irish Republic may partially fund
the scheme.
17 Jul 2007 - Northern
Ireland Executive accepts offer of money
and agrees to proceed with the scheme.
11 Nov 2008 -
Preliminary route options published
5 August 2009 -
Preferred route announced
Emerging design
published - Aug/Sep 2010
Environmental Statement
/ draft orders - January 2011
Formal public
exhibition - 25-26 Jan 2011
Public inquiry held
15-23 June 2011
Work due to commence by
2013 (as of Apr 2008) subject to public
inquiry
|
|
Cost
|
£113m (as of
August 2009)
See
important note on costs below.
|
|
Photos
|
See below |
|
See
Also
|
General
area map
Official
web site on scheme - Roads Service
A8 Corr's
Corner to Coleman's Corner on this
site
A8
Ballyedward to Larne Harbour on this
site
Ballynure
Southern Link road on this site
|
The A8 is the principal route from Belfast to the
major sea port of Larne, where a large percentage
of Northern Ireland's freight (and a smaller
percentage of Republic of Ireland freight) enters
arrives and departs. The A8 runs from the M2 at
Glengormley to Larne and also forms part of
European Route E01. Approximately a third of the
route is already dualled, consisting of a stretch
at the south end and a stretch at the Larne end.
Although the remaining road is straight and well
built, the presence of large numbers of HGVs on
the route means that the average speed is lower
than for other similar roads. As of 2008 the
average traffic level was 18,000 vehicles per day,
close to the upper limit for a single-carriageway
road. This project, which is being supported by
the Irish Republic, will see the remainder of the

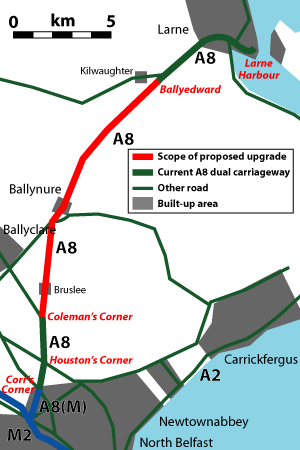

road dualled to a high standard. The map below
shows the approximate route proposed in
red, with new grade separated junctions marked by
blue dots and roundabouts by red dots. For a more
detailed map, see
here.
Route and Standard
The road will be built as a "Category 6"
dual-carriageway. This is the highest standard for
an all purpose road, and is one step down from a
motorway. It means that the road will have two
lanes in each directon, no breaks in the central
reservation and all junctions either grade
separated, limited to left-turns only or be in the
form of roundabouts. The road will have 1 metre
hard strips on each side.
For a detailed PDF map
of the route, as announced in August 2009, click
here. The route is essentially an online
upgrade of the existing road, with two exceptions:
- Starting at the existing Coleman's Corner
roundabout (Hillhead Road turnoff) the new road
runs online as far as Ballynure, except for a
short detour round the east side of Bruslee
hamlet.
- On this stretch there are a pair of
Left-in/Left-out junctions at Lisglass Road; a
compact grade separated junction to serve
Calhame Road/Green Road/Legaloy Road.
- At Ballynure the road diverges offline to the
west before the current A57 roundabout. A grade
separated junction here serves the A57 and the
south side of Ballynure.
- Continuing round the west of Ballynure, in the
Six Mile Water valley, the road rejoins the line
of the current A8 north of Ballynure at
Ballybracken Road where there is another grade
separated junction.
- The road then continues online all the way to
the A36 Shanes Hill Road junction (townland of
Ballyedward), where there will be a new at-grade
roundabout. Along this stretch there will be
compact grade separated junctions at Moss Road
and Deerpark Road/Park Road.
The picture below was
put on the Roads Service web site (here)
in August 2009 and shows how the new road may
look. The visual anticipates quite heavy traffic.

Historical Background
Larne Council have been campaigning for the route
to be dualled but until 2006 Roads Service had no
plans to proceed in the following 10 years.
However, during the optimistic political
developments of April 2007 the Irish government
offered a "peace dividend" to build infrastructure
in Northern Ireland. The two schemes to benefit
were the dualling of the A5 from Londonderry to
the Irish border at Aughnacloy, and this scheme to
dual the A8.
Between 1999 and 2000 a detailed study was
carried out on the A8 with a view to improving the
route. This resulted in the construction of a
short stretch of dual-carriageway between
Houston's Corner and Coleman's Corner (at the
south end of this project), a roundabout with
climbing lanes at the south side of Ballynure, the
Ballynure Southern Link Road. Funding at the time
was limited, so a full dualling scheme did not
take place. Plans to widen the rest of the A8 to
dual-carriageway standard had however been on the
cards for some time and in fact a road protection
corridor exists for the entire route.
However, in the eight years since then the
funding level has increased dramatically. This
means that the current planners are no longer
limited by the route protection corridor. They are
now able to examine other options, including
partly or fully offline routes for a new road, and
more ambitious junction improvements, including
grade separation (ie flyovers). The public
consultation held in May 2008 informed the public
of this newfound freedom and prepared landowners
on the route for some of the options that may be
proposed as the scheme develops.
The Ballynure
Southern Link Road (a bit like the
south-eastern quarter of an imaginary ring round
Ballynure) opened in 2005, prior to the decision
to upgrade the whole A8. At the time there was a
suggestion that it could one day be upgraded to
dual-carriageway and form part of a new eastern
bypass around Ballynure. However the consultants
have now said (as of November 2008) that this will
not happen as the alignment of the road is not
good enough for the proposed Category 6
dual-carriageway.
Progress
12 Nov 2011: Roads Service apparently
now have the Inspector's Report on
June's Public Inquiry, but are not planning to
release it until March/April time next year
when it will be released along with various
other documents, such as the Vesting Order.
All the media attention of the past week has
been on the implications of Wednesday's
withdrawal of Dublin's promised £400m on
the A5. However, they seem to be forgetting
that the money was also to part-fund this
scheme on the A8. For simplicity, on paper all
the £400m was to have been paid to the
A5, but this was purely for bureaucratic
expediancy. The A8 scheme is being progressed
by Roads Service on the assumption that this
£400m was coming. So the announcement
throws up lots of question marks about this
scheme. There are two things that work in the
scheme's favour. Firstly, the DRD needs to
spend the spare cash quickly, and the A8 is
one of only three schemes that have already
had their public inquiries and hence could
proceed soon (the other two being A6
Randalstown-Castledawson and A2 Greenisland;
ignoring the A5). Secondly, at £113m the
scheme is considerably cheaper than the A5 and
still quite affordable by Stormont alone. By
contrast, I think it's improbably that Roads
Service would regard this as the most eligible
scheme if everything was on a level playing
field. The future of the A8 scheme is thus
wide open at this point.
4 Jul 2011: The Public Inquiry
opened on 15th June and concluded
on 23rd June. We now have to wait to see what the
Inspector's recommendation will be. It is likely
to take a few months to compile the report, which
I speculate we could expect in the Autumn.
14 May 2011: Roads Service have
announced that the Public
Inquiry into this scheme will begin at 10am
on 15th June 2011, in Corr's Corner Hotel. This is
slightly earlier than was anticipated last May.
They have also released an addendum to the
Environmental Statement. Basically this is needed
because the designers have tweaked the design a
bit, so that (for example) in some places the road
is lower than originally planned, and in others
higher. This means that some of the noise
calculations, etc, needed to be re-done. As
always, I would urge all those with an interest in
this proposed scheme to turn up to the Inquiry as
this is the key event for expressing concerns.
14 Jan 2011: The DRD has released
its draft budget for the period 2011-2015.
This shows that the A5 and A8 schemes are being
progressed at all costs - all other schemes (with
the exception of the Cherrymount Link in
Enniskillen) have been put on hold until at least
2015 in order to ensure there is sufficient money
for the A5 and A8. Even so, the budget assumes
that the £400m contribution from the Irish
government comes through (see previous update).
The decision to press ahead with the A5 and A8
will certainly provoke debate because (a) a number
of smaller schemes are being sacrificed to allow
the A5 and A8 to proceed and (b) the Irish
government contribution carries a high risk of
withdrawal. Meanwhile, work is proceeding on this
scheme with a public exhibition
of the latest proposals scheduled for 25 and 26
January. It will be held in Corr's Corner Hotel,
Newtownabbey from 2pm to 9pm. As always, I
strongly encourage all those with an interest in
the scheme to turn up as this is a key event for
getting your views across. This will coincide with
the publication of the draft Environmental
Statement (setting out the impacts of the scheme)
and three draft Notices (setting out changes to
private accesses onto the A8, listing land that
will be purchased for the scheme and a notice that
provides the legal basis to construct a new trunk
road).
23 May 2010: Roads Service have
now completed the 'high level review' into the
route of the scheme at Ballynure (see update on 14
Dec 2009). They have decided that their original
plan (western bypass of the town) is still the
best option. They studied several variations of
the original online dualling option through
Ballynure to see if any of them performed better
than the option that was rejected. However, they
did not. In fact, they were worse: "none of
the alternative online dualling options through
Ballynure performed as well as the original
option assessed at Stage 1 (at-grade solution
with a signalised junction and 40mph speed
restriction)" [source].
The full report can be read
here. They also concluded that an online
dual-carriageway would create a major visual
barrier through the village, would require the
closure of further road accesses onto the A8 and
require the demolition of "a significant number of
buildings". In addition, the presence of the
Ballynure Water meant that any bridge would have
to be around seven metres above ground level,
which would visually be a significant sructure in
the centre of the village. Roads Service therefore
plan to press ahead with the western bypass
option. According to a written
answer in the Assembly, there will be
another public exhibition (the "emerging specimin
design exhibition") in August or September 2010.
The Public Inquiry is still scheduled for late
2011.
22 Feb 2010: Roads Service awarded
the £113m contract for this scheme to the
Lagan/Ferrovial/Costain consortium on 26 January
2010. The contactor will initially work on the
design and legal process around the new road,
before hopefully following that up with the actual
construction. Roads Service estimate that about
200 jobs will be created for the duration of the
construction phase. Roads Service have also said
that the next round of public consultations - when
they plan to reveal the detailed design of the
road and its junctions - will be in "mid to late
2010", while the formal public consultations will
take place in "early to mid 2011" following the
publication of the necessary legal documents.
23 Jan 2010: Roads Service
intend to proceed to appoint a contractor for this
scheme. Letters stating their "intention to award"
were sent out two weeks ago, according to their
web site. The stage 3 assessment is now underway -
this means they will refine the preferred route
that was announced in August, producing actual
designs for the various junctions and perhaps
tweaking the exact route.
14 Dec 2009: There has been much
debate and publicity in recent weeks about the
choice of route of the A8 at Ballynure. The eight
local farmers who are affected by the proposed
bypass to the west of the village along with local
politicians, most notably from the UUP, have
argued that the bypass uses an unacceptable amount
of good agricultural land. They contend that it
should be possible to route a grade separated
dual-carriageway along the existing route through
the middle of the village, despite the fact that
this is likely to be more challenging. They argue
that this would not increase sevarance, since the
road is already there. A
week ago Danny Kinahan of the UUP said that
he had secured a committment to a 'high level
review' of the A8 plans by Roads Service. There
have been no independent public statements from
Roads Service on the issue.
2 Nov 2009: Roads Service have
said that the draft vesting order should be
published in early to mid 2011. They have also
clarified that four properties will have to be
vested, and that these consist of "a private
dwelling, a building site, a derelict building and
an agricultural barn" and that the cost of these
is expected "to be in the region of
£550,000". Meanwhile, Roads Service have
said that land to be vested will impact on
99 landowners, at at total cost which is "in the
region of £8 million".
10 August 2009: The preferred
route was announced
last Monday. Details and maps are available on the
Roads Service web site here.
The public exhibition last week was apparently a
great success, with almost 800 people turning up
to view the proposals. The cost is now being given
as £113m, within the limits predicted last
May (£105m-120m). The route chosen is
largely an online upgrade of the existing road,
but the designers appear to have done this without
compromising safety. All junctions are either
compact grade-separated junctions or left-turns
only. There is one at-grade roundabout at the
northern terminus of the scheme. For details of
the route, see the section entitled "Route" above.
However, it is worth noting that the decision has
been made to bypass Ballynure to the west,
principally because a bypass to the east would
encourage HGVs heading from Larne to the West
along the A57 to continue to go through the
village. The hamlet of Bruslee will also remain
intact, since the decision has been made to bypass
it to the east.
27 July 2009: The Minister for
Regional Development will announce preferred route
for the dual-carriageway on 5 August 2009. This
will be followed by a two day public exhibition at
which members of the public will be able to view
the developments. The exhibition will be held at
Corr's Corner Hotel, Newtownabbey (on the A8) on
Wed 5 August and Thu 6 August from 2pm to 9pm. I
would strongly encourage all
those with an interest in the scheme to turn up as
this is one of your main opportunities to get your
views across and ask questions.
12 July 2009: According to Roads
Service, the preferred route for the scheme is due
to be announced in "early August" 2009. This will
then be followed a public exhibition where those
with an interest in the scheme can turn up and
express their views.
13 May 2009: According to the Deputy
First Minister the cost of this scheme has
now been more accurately estimated as between
£105m and £120m. He also said that
they have been assured that the Irish government's
committment to financially support this and the A5
scheme remains secure. According to the Regional
Development Minister, the preferred route is
to be announced in mid-summer 2009. The
procurement process is also due to commence
shortly.
23 May 2008: Roads Service held
a preliminary public exhibition about the scheme
on 20 and 21 May 2008. The aim of this was to
inform landowners and other interested parties
about the scope of the project and to keep them
informed as to the process that would be followed.
It was revealed that the next milestone will be
the announcement of the preferred route in Summer
2009. They also said that scheme delivery would be
between 2013 and 2018, rather than simply "2013"
as stated in the document "Investment Delivery
Plan for Roads". Finally, the scheme now has an official
web page, although at the minute it does not
seem to be linked from anywhere on the Roads
Service web site!
28 Apr 2008: According to the "Investment
Delivery Plan for Roads" document released
in April 2008, this scheme has now been placed
into the "Preparation pool" for schemes likely to
proceed within 5 years, ie by 2013.
14 Sep 2007: At the fifth
plenary meeting of the North-South
Ministerial Council in July the Northern Ireland
Executive "confirmed its acceptance, in principle,
to taking forward these two major road projects."
and stated that "The road project from Belfast to
Larne will be taken forward by the Northern
Ireland Executive and its agencies." No timeline
has been stated, but it is likely that the scheme
will progress within the next ten years.
Note on Costs
In 2007 the Irish government offered £400m
to the Northern Ireland Executive to be used for
the upgrade of the A5 between the Irish border
near Aughnacloy and Londonderry, and the A8
between Newtownabbey and Larne. In July 2007 the
Executive accepted the funding. In November 2007
the Executive announced that they would proceed
with both schemes. Although the Irish government's
contribution is intended to help with both
schemes, it has been agreed for simplicity that
the money will be applied to the A5 project only.
Photos

Bruslee hamlet straddles
the A8. Here seem looking towards Belfast in 2006.
If the road protection corridor is used (and it
may not) the widening would be on the far side of
the road. [Wesley Johnston]

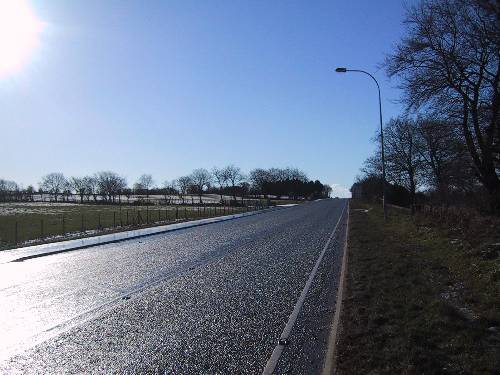

The A8 climbing towards
Belfast from Ballynure, seen in 2004. A climbing
lane has since been added here. [Wesley Johnston]

The
Ballynure Southern Link road opened in 2005 to
allow vehicles heading to Carrickfergus from the
A8 to bypass the village centre - will it be
upgraded as part of this proposed scheme and
become part of the A8? [Wesley Johnston]
|
