Sustainable Transport Enabling Measures (STEM), Belfast



Status
Construction scheme (current)
Where
To add new bus lanes, cycle lanes and pedestrian crossings in Belfast City Centre by reducing road space for general traffic, and creating a new one-way gyratory west of the city centre.
Total Length
Includes 2.6km of bus lanes and 1.3km of cycle lanes
Dates

Proposed as part of "Belfast on the Move" scheme - 30 Sep 2010
Public consultation Oct and Nov 2010
First bus lane came into operation - 21 Nov 2011
Hope Street & Durham Street schemes began - 6 Jan 2012

Hope Street scheme to be complete - early May 2012 (as of Jan 2012)
All STEM works due to be complete mid 2013 (as of Jan 2012)

Cost
£3.5m
Photos
See below
See Also
Official web site on scheme - DRD
Original Sep 2010 press release - DRD
Map of proposals - DRD (PDF)
Belfast Rapid Transit System - on this site
Streets Ahead Enabling Measures Phase 1 - on this site
Rapid Transit Enabling Measures - on this site
Streets Ahead Enabling Measures Phase 2 - on this site

Belfast is currently undertaking a long-term scheme to redirect general traffic flows out of Belfast city centre, in order to permit a greater role for buses, rapid transit, pedestrians and cycling. The work is being carried out in six phases, of which this scheme is the second (Phase 1 was completed in 2011 - see links above):
  1. Streets Ahead Enabling Measures Phase 1
  2. Sustainable Transport Enabling Measures (STEM)
  3. Rapid Transit Enabling Measures
  4. Streets Ahead Enabling Measures Phase 2
  5. City Centre Ring Road Southern Section
  6. Transforming the City Centre Ring Road

Phase 2 involves taking road space away from general traffic and using it to provide new bus and cycle lanes. In some cases, the capacity of the road for general traffic is being reduced from four to two lanes. To the west of the city centre a one-way system is being introduced to take traffic off Great Victoria Street to enable greater bus priority. The proposals are too detailed to describe in text, but a summary is as follows:

  • 2.6km of new bus lanes throughout the city centre.
  • 1.3 km of dedicated cycle lanes in the city centre.
  • 20 new signalised pedestrian crossings and 40 disabled parking spaces.
  • Creation of a clockwise gyratory on College Square East -> Grosvenor Road -> Durham Street -> College Street.
  • To make Hope Street two-way, to facilitate...
  • Great Victoria Street to become one-way southbound.

Much more precise proposals can be seen on the map released by the DRD in September 2010. See page 2 of this PDF file. The entire process is due to be carried out from late 2011 to mid 2013.

The map below is a DRD map and shows the proposed one-way system west of the city centre. Eventually the plan is to take all general traffic off Donegall Squares North and South, ie from in front of and behind City Hall.

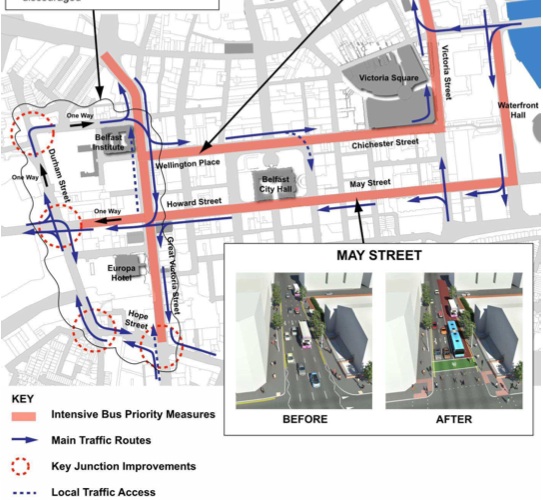

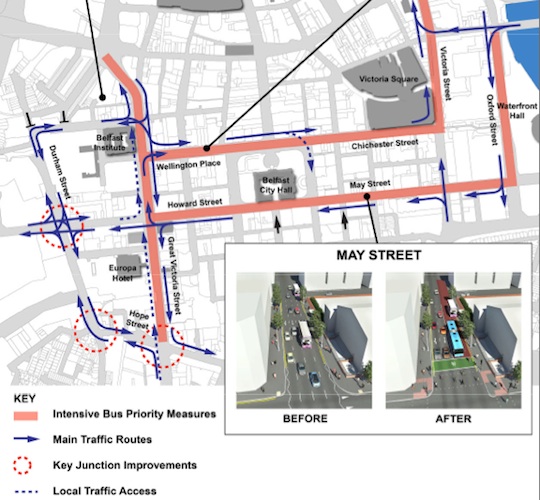

Map of proposed changes as part of the STEM project as of 2011 [DRD from here].

Updates

1 May 2012: The DRD posted an update on their web site about five weeks ago, including images, which I have only just found. It indicates that work began on the junction modifications of Hope Street/Great Victoria Street on 30 January 2012, and that work began on the modifications of the Grosvenor Road/Durham Street junction a week earlier, on 23 January. Work at the Durham Street junction is due to take four months, which would suggest there is still a month of work to go here. However, the update suggests that all the associated works will not be completed until the end of June. Meanwhile, the new traffic signals at the Sandy Row/Hope Street junction (the bottom left junction on the map above) went live on 16 April 2012. Great Victoria Street remains two way for now, but this will change next year – I assume that the next part of the project will be to modify College Square North and Durham Street (beside Belfast Institute on the map above) as this will also need to be completed before the one-way gyratory can be implemented. Although these changes may seem like tweaking, they are part of a bigger plan and will facilitate increased priority for buses, cyclists and pedestrians in the central part of the city.

7 Jan 2012: The first of the proposed bus lanes (on Victoria Street) came into operation on 21 November 2011, and operates from 7am to 7pm according to this press release. Meanwhile, work on the scheme to make Hope Street two way gets underway in two days (on 9 January) according to this press release. This will not only involve converting Hope Street into a two-way road, but also upgrading the junctions at either end of Hope Street, and Grosvenor Road/Durham Street junction. The work will take four months, but the press release implies that Great Victoria Street will remain two way at that point, only becoming one way once the one-way system at College Square is completed. The same press release implies that all of the STEM works are due to be completed over the next 18 months, ie by mid 2013.
