|
|
Status
|
Construction scheme
(future) |
|
Where
|
To
upgrade the entire A5 to dual-carriageway
from the Irish border near Aughnacloy, via
Omagh and Strabane, to Derry. |
|
Total
Length
|
88 km / 55 miles |
|
Dates
|
17 Jul 2007 - NI
Executive agrees to proceed with the plan
14 Nov 2007 -
Consultants appointed to select preferred
route
7 Nov 2008 - Preferred
route corridor [not exact route] announced
Feb 2009 - Route
options displayed to the public
21 July 2009 -
Preferred route announced
Nov 2010 - Pre-orders
Exhibition and draft statutory orders
published
9 May to 1 July 2011 -
Public Inquiries held
9 Nov 2011 - Irish government withdraws
funding offer (officially on 10th)
Late 2011 - Inspector due to submit
Reports into Public Inquiries
Early 2012 - Reports into Public Inquiries
due to be published
Construction on hold
until at least 2016 (as of Nov 2011)
(changed from
"2012" as of Feb 2009)
|
|
Cost
|
£844m (as of
August 2009)
(revised from
£650m - £850m as of Nov 2008)
Initially calculated to
be approx £560m in 2007
Irish government is
contributing £400m to this scheme
and the A8 upgrade
(See important
notes on costs below when
interpreting these figures)
|
|
Contractors
|
Section 1
(Newbuildings to south of Strabane) - BAM,
Balfour Beatty, FP McCann, ARUP, Atkins.
Section 2
(South of Strabane to south of Omagh) -
Sisk, Roadbridge, PT McWilliams, Fehily
Timoney Gifford.
Section 3
(South of Omagh to Aughnacloy) - Graham,
Farrans, Scott Wilson, Halcrow.
|
|
See
Also
|
Official web
site on scheme - A5WTC
General
area map
Strabane
Lifford Link Road on this site
N14
upgrade - Donegal County Council (on
hold as of Oct 2010)
Alternative
A5 Alliance - group opposed to the
scheme
We
Support the A5 - Facebook group
supporting the scheme
|
Click here to
jump straight down to updates for this scheme
This ambitious road
scheme, which is being progressed thanks partly to
£400m of the necessary funds being made
available by the Republic of Ireland, will be the
single largest road scheme ever undertaken in
Northern Ireland. The plan is that, in one single
project, almost the entire 55 mile long A5 will be
upgraded to a high-quality dual-carriageway. The
A5 is the main north-south route in the west of
the province connecting the A4/M1 route which runs
across the south of the province to the A6 route
which runs across the north. It serves the
principal towns of Omagh and Strabane along the
way, as well as terminating in Londonderry city.
From an all-Ireland perspective the A5 is an
extension of the Irish N2 road, the main route

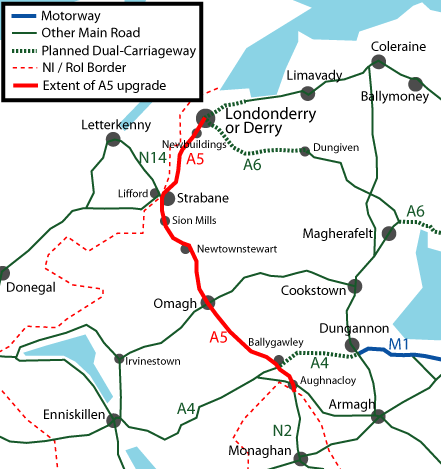

from Dublin to Derry and Donegal. The map below
shows the existing A5, with the proposed route
approximately illustrated by the red line. Scroll
down for links to more details maps.

The standard of the
proposed road is very high (technical term is
"Category 6"). It will consist of two 7.3 metre
carriageways with 1 metre hard strips on either
side and a 2.5 metre crash barrier, as shown
below. The central reservation will be continuous,
ie there will be no right-turns. This means that
all junctions will be either grade separated, be
limited to left-in/left-out movements only, or be
at-grade roundabouts.

clipped from a PDF on the A5WTC
site at
this location.
Route
The most
detailed route maps are downloadable
from the A5WTC site, under "Brochures" and
as of November 2010 show what is very likely to be
the finalised route. Junctions on the new road are
a mixture of full-scale grade-separated junctions
(like proper motorway junctions), compact
grade-separated junctions (such as have been built
recently on the A1) and ordinary roundabouts. The
strip map below shows the various junctions
proposed. The numbers are as given in document
released in November 2010, but are probably for
reference only. Interestingly, the proposed road
will set a new record for the longest stretch of
dual-carriageway/motorway with no junctions in
Northern Ireland: the 14.6 km/9.1 mile stretch
between Seskinore and Ballygawley.
|
NORTH
Begins as
A5 Victoria Road, Newbuildings
(approx 2
miles / 4 km south of Londonderry)
|
|
Junction
1:
Newbuildings (north)
|
|
|
B?? Victoria Road
(current A5)
|
|
1
lane each way – 1.3 km / 0.8
miles
|
|
Junction
2:
Newbuildings (south) |
.
|
|
Link road to B??
(current A5)
|
| |
13.0 km / 8.1 miles
|
|
Junction
3:
Strabane (north)
|
|
|
B?? (current A5)
B?? (current A5)
into Strabane
|
| |
2.9 km / 1.8 miles
|
|
Junction
4 / 5:
Strabane (centre)
Access to/from the
north only.
|
Access to Park Road
.
A38 Lifford
Road
|
|
B?? (Current A5)
Railway Street
(town centre)
B?? (Current
A5)
|
| |
0.5 km / 0.3 miles
|
|
Junction
6:
Strabane (centre)
Access to/from
the south only.
|
|
|
B?? (Current A5)
Bradley Way
(town centre)
B?? (Current
A5)
|
| |
1.3 km / 0.8 miles
|
|
Junction
7:
Strabane (at Urney Road)
No access to local
road network.
A5
turns at 90° via roundabout.
|
Proposed link to
N14/N15 in Donegal
(see
here)
|
|
|
| |
2.6 km / 1.6 miles
|
|
Junction
8:
Strabane (south) / Sion Mills
|
|
|
B??
(Current A5)
into Strabane
B?? (Current A5)
into Sion Mills
|
| |
|
Junction 9:
Victoria Bridge |
|
|
B72 Fyfin Road
into Victoria Bridge
|
| |
5.8 km / 3.6 miles
|
|
Junction
10:
Newtownstewart
|
Drumlegagh
Road North
B84 Baronscourt Road
.
|
|
B84
Baronscourt Road
into Newtownstewart
|
| |
12.0 km / 7.4 miles
|
|
Junction
11:
Omagh (north)
|
|
|
B?? (Current A5)
Beltany Road
A?? (Current
A5)
Beltany Road
Into Omagh
|
| |
5.7 km / 3.5 miles
|
|
Junction
12:
Omagh (west)
|
A32 Clanabogan Road
("Dromore Road")
towards Enniskillen
|
|
A32
Clanabogan Road
("Dromore Road")
into Omagh
|
| |
4.0 km / 2.5 miles
|
|
Junction
13:
Omagh (south)
|
B83 Seskinore
Road
|
|
A??
Doogary Road
(Current A5)
into Omagh
B?? (Current A5)
|
| |
6.7 km / 4.2 miles
|
|
Junction
14:
Seskinore
|
B46 Moylagh Road
into Seskinore
Augherpoint
Road
|
|
B46
Moylagh Road |
| |
14.6 km / 9.1 miles
|
|
Junction
15:
Ballygawley
|
A4 Annaghilla Road
towards Enniskillen
|
|
New
link road
into Ballygawley
A4
dual-carriageway
towards Belfast
.
|
| |
4.9 km / 3.0 miles
|
|
Junction
16:
Aughnacloy (north)
Access to/from
the north only.
|
B?? (Current A5)
Tullyvar Road
into Aughnacloy
|
|
B?? (Current A5)
Loughans Road
|
| |
3.5 km / 2.2 miles
|
|
Junction
17:
Aughnacloy (south)
|
Caledon Road
into Aughnacloy)
|
|
A28
Caledon Road
towards Armagh
|
| |
1
lane each way – 1.5 km /
0.9 miles
REPUBLIC OF IRELAND
BORDER
Continues as N2 to Dublin
SOUTH
|
Cross
Border Funding
The Republic of Ireland agreed to part-fund the
scheme as part of the St
Andrews Agreement of 2006. The offer of
funding from the Republic of Ireland was accepted
by the Northern Ireland Executive at a plenary
session of the North-South Ministerial Council on
17 July 2007. This committment has remained, even
after the major funding cutbacks announced by
Dublin in November 2010 - see the update below on
25 November 2010 for more information. Due to its
size, and its cross-border nature, the project is
being managed by a three-tier structure which is
(starting with the most senior) (a) Cross Border
Steering Group (b) Technical Group and (c) Project
Team.
Updates
12 Dec 2011: Many
people are understandably keen to know what is
going to happen about the A5 now, and indeed what
will happen with other planned schemes in Northern
Ireland. Last week the Minister for Regional
Development answered questions about the A5 in
the Assembly. He said that he would not be
making any decisions until at least two things had
been done. Firstly, he intends to wait until the
Inspector's report into the Public Inquiries into
the A5 is published, likely to be January 2012. He
will then wait for this to be considered, any
changes made to the plan and the new plan is
costed to give a final budget estimate. Secondly,
he intends to wait until after the DRD has had a
discussion with the Irish Department of Transport
to decide exactly how the funding is going to work
now, a meeting that is also expected in January
2012. On this matter he said "That process will,
undoubtedly, affect the funding that is
available to my Department and, therefore,
potentially, delivery of the strategic roads
programme." Thirdly he needs to wait
until it is known just how much of Stormont's
money for the A5 is going to be reallocated back
to the DRD. Since the money was designated
specifically for the A5, not roads in general, it
needs to go back to the source before being
re-allocated to departments. In other words, we
cannot assume yet that the money will be made
available for other road schemes. Of these three
reasons, it is the latter two which are key. While
it is important to know the final budget figure,
it is hardly going to be so divergent from the
current estimates that a decision on construction
has to be held off until then. So the main reason
for the delay is that the DRD simply does not know
how much money it will have either from Stormont
or from the Irish government for the next few
years. Until these questions are settled, things
will probably continue in limbo much as they are
now.
The only other news on the scheme is confirmation
in a Written
Answer that the contracts with the
contractors were in two stages: the first was
design, and the second was build. The three
sections of the A5 will only progress to the
"build" phase in the event of the money being
available and the road getting the legal go-ahead.
Therefore, while it is a massive blow to the
industry, no compensation will be due to them.
12 Nov 2011: Yesterday,
following a meeting between the Irish Taoiseach
and the First and Deputy First Ministers, it was announced
that Dublin now WILL be providing some funding for
the scheme, abeit €50m/£42m (around 10% of
the amount previously announced) with half paid in
2015 and half in 2016. Full details will be
revealed on Friday 18th, when there is a meeting
of the North-South Ministerial Council. The Deputy
First Minister was quoted on UTV
as saying "I
think it's fair to say it's back on track
again". I would advise taking this with a
large pinch of salt, however. Before last
Wednesday's announcement, the whole scheme was due
to get underway next year. Even with today's
revelation, there seems little prospect of any
significant work being underway even by 2016.
£42m is barely enough to build 5% of the
road, and Stormont could certainly not stump up
the remaing 95% in that timeframe. I would see
this, instead, as a token gesture by Dublin in the
face of political pressure to prove that they
remain committed to the scheme. So what will
happen next? If the scheme does indeed proceed as
designed, the only way any work could get underway
in the next 5 years + would be to build smaller,
isolated sections as separate schemes. The most
arguable sections are: the bit bypassing Omagh;
and an upgrade of the stretch from Strabane to
L'Derry, both of which were live proposals before
the main A5 scheme was even thought of. Perhaps
there will be more details on Friday, but either
way I think it's fair to say that the scheme is
now of a fundamentally different nature.
9 Nov 2011: Well,
I find myself adding yet another update on this
project - but this time it is bad news for the
scheme. The Irish
government has said that they cannot afford to
provide the £400m funding in the
period up to 2016 - the official confirmation of
which is due tomorrow. Since Stormont cannot
possibly afford the whole cost of the scheme, this
effectively means the project will be put on ice
until at least 2016. Contrary to some what some
headlines have said, the Irish government has said
that it remains "politically" committed to the
scheme, so the problem is one of current
affordability. A spokesperson said "The [Irish]
Government remains politically committed to this
project, however - given the tight fiscal
constraints - roads investment will be focused
on maintaining existing roads, rather than
developing new routes. It is therefore not
anticipated that significant resources will be
available for this project over the medium term."
In other words, the scheme is still a live plan
and could still happen - just not in the
foreseeable future. My comment at the end of
October that the DRD Minister was planning to
re-profile the timing of the A5 scheme has been
confirmed by Sammy Wilson who today said that "we asked them [the
Irish government] to consider a possible
re-profiling of the project. However, given the
current fiscal environment within Republic of
Ireland, Dublin Ministers indicated that the
greater priority was funding urgent schemes
within their jurisdiction." This is quite
understandable, from an objective standpoint. The
DRD Minister Danny Kennedy said "This news is
extremely disappointing with major implications
for the A5 and A8 schemes. This is a commitment
of the Irish Government, confirmed at the North
South Ministerial Council. Clearly it will be a
major item for discussion at the NSMC plenary".
Needless to say, the decision has been met
with uproar in Donegal and also in Tyrone,
the two areas which would most have benefitted.
The money allocated by the Stormont Executive
could now be re-allocated, and not all of it may
come back to the DRD. But if it does, I would
expect to see some movement on the A6 dualling
schemes and the A2 at Greenisland, both of which
were postponed to allow the A5 to proceed.
Finally, although it may well have been discussed
at the time, it is also worth clarifying that the
text of the 2006 St
Andrew's Agreement contains no reference to
the A5 or any other road scheme.
30 Oct 2011:
In July the Minister indicated that he might
be able to outline his position on the A5 "in or
around October" (see below update 4 July). Since
the Minister's own party made a reappraisal of the
A5 one of its manifesto pledges last May, the
absence of such a statement has created
uncertainty for both supporters and opponents of
the scheme. However, in a Question
for Written Answer in the Assembly two weeks
ago, the Minister indicated that he would now not
be making a statement on the subject until "early
2012", ie after the Inspector of the four Public
Inquiries (held in May and June) has reported
back. Roads Service expects to get the reports
before the end of 2011, but will not make them
public at that time as they will take time to
formulate their response before publishing.
Reading between the lines of recent events, it
seems likely to me that the Minister will go ahead
with the A5 scheme, but perhaps with a different
timetable.
For those interested, one of these Questions
for Written Answer from a week ago contains
a detailed breakdown of current traffic levels at
various locations on the A5, showing a wide range
from 6,503 per day south of Ballygawley to 21,595
on the Omagh Throughpass. 18,000 is generally
considered the maximum that a single-carriageway
road can safely accomodate.
Finally, the same Questions
for Written Answer page shows when the Irish
contribution of £400m to the A5/A8 schemes
are currently planned to be made, showing a heavy
skew towards 2014-16, ie when the road is planned
to be nearing completion which may also explain
why the Irish government doesn't seem to regard it
has a big deal right now, despite the economic
meltdown:
2009/10 - £8m
|
2010/11 - £0m
|
2011/12 - £14m
|
2012/13 - £0m
|
2013/14 - £10m
|
2014/15 - £250m
|
2015/16 - £118m
|
|
8 Oct 2011: There continues to be slight
uncertainty about when exactly the Minister
plans to press ahead with this scheme. Until now the
official position has been as
described in July: "Roads Service
has currently been allocated a sizeable
capital spend of nearly £1.2 billion
over the four year Budget period. However,
two-thirds of this, almost £800
million, is presently allocated to two major
road schemes, [the A5 and A8]. This leaves
little for other schemes. Upgrades of the
A32, to improve access to the new hospital
at Enniskillen, are anticipated to start
this year.... The budget does not allow for
any other major works to start until 2014/15
when over £60 million is available." There is now
evidence that he may be planning to
"reprofile" it rather than cancel it. This
basically means spreading the project out over
a longer timescale, hence reducing the amount
of money that is needed each year. This would
allow a bit more money to be made available
for other projects in each of the next few
years. The minutes
of a meeting in July (just published)
contains the first clue: "[Head of Roads
Service Geoff Allister] Geoff said that
Roads Service would continue with
development work, including progression
through the statutory processes, so that
possible schemes could be “parked” at an
appropriate point, to be re- activated
should finance become available." The
second clue came this week when the Minister announced
that the had brought forward plans to re-lay
the Belfast-Derry railway line to 2012/13.
Although the press release doesn't say where
the £27m needed initially is coming
from, the BBC
article quotes a Sinn Fein MLA claiming
that the money is being taken from the A5
budget. This could only happen through a form
of reprofiling such as outlined above. But at
this point there is no indication that Danny
Kennedy is planning to axe the A5 upgrade.
It has
also been
revealed that, to date, £38m has
been spent on this project of which
£29.8m has been spent on the project
consultants (those doing the land surveys and
detailed design). The £38m figure
represents 4.5% of the total estimated project
cost, and while it is a very large sum in
absolute terms, is not surprising or excessive
for a project of this scale. It does, however,
serve to illustrate how reprofiling the scheme
could lead to significant benefits for other
projects.
For
those interested, Roads Service has now put
the complete
transcripts of the two-month public inquiry
onto their web site. The inquiries were held
during May and June. It is also confirmed that
the proposed Strabane-Lifford
Link Road will be going ahead as part of
the A5 scheme - as evidenced by the Direction
Order which was published on 19 July
2011.
4 Jul 2011: As we know, the
"Roads" Minister has indicated that he will
consider the future of this scheme only once the
public inquiry has finished an the Inspector has
submitted his report. In a question-and-answer
session in Stormont two weeks ago he said
that "my expectation is that I will have the
report of the public inquiry in the early autumn"
and went on to say that "it may be possible to
outline things [his response to the report] in
or around October." Although this is
couched in vague terms, it at least gives us some
idea when we might know his thoughts on
progressing the scheme. Two weeks ago some very
strongly worded comments were made
in Stormont by the deputy First Minister: "There
is no question about the road. However,
questions remain about the outcome of the
inquiry, about whatever discussions officials
will have in the aftermath of the inquiry and
about how they take forward the project. The
project is very far advanced. Contractors have
been informed that they have the tenders for
three stages of the road. I think that the
project is unstoppable. It is now a matter of
how it is taken forward to try to minimise the
costs to our Administrations, North and South."
While he does acknowledge that there is a current
Public Inquiry, I feel it is inappropriate for
such a senior government figure to describe a
scheme that is the subject of an ongoing public
inquiry as "unstoppable". Such language
undermines the legitimacy of the Inquiry and will
create an impression that it is merely a
rubber-stamp with no actual purpose, a box-ticking
exercise that must be completed before we can move
on. Public Inquiries are a vital part of the
democratic process, and on this site I always
encourage as many people as possible to
participate. Unless a public inquiry carries the
real possibility of leading to a recommendation
that all or part of a scheme not go ahead, then it
is a pointless exercise.
5 Jun 2011: As the Public
Inquiries continue (the Section 2 one being due to
begin tomorrow), there is at last some certainty
from the new leadership in Dublin. The Irish Prime
Minister Enda Kenny has somewhat surprisingly publicly
reaffirmed his committment to the Irish
contribution of £400m. He said: "The
previous government had committed to put money
in there and we will honour that commitment".
However this certainty has been replaced by much
more uncertainty from the new
Roads Minister Danny Kennedy who has signalled
that he will review
the scheme, but that he will do so only
once the public inquiry has been completed
and the inspector has submitted his report (likely
to be some months away). Danny Kennedy is from the
Ulster Unionist Party which is much cooler on this
scheme than the previous Minister Conor Murphy who
is a member of Sinn Féin. The media also
quote Roads Service as saying that design work on
the scheme has already cost £35m – although
this is hardly surprising given how advanced the
scheme is. In recent months we were all wondering
whether events in Dublin would kill this scheme,
but we are now suddenly in the situation where it
is events in Belfast that will decide it.
14 May 2011: The first of the
four public inquiries began on 9th May in Omagh.
This one is looking at the entire scheme and its
rationale. I don't intend to provide a
blow-by-blow account of the inquiry on this site,
but this
news story from the Irish Times yesterday
provides a useful summary of the case against the
road being made by the environmental lobby using
the umbrella term "PlanBetter". The article also
claims that Irish Taoiseach Enda Kenny has said
that the planners of the A5 should "look at making
savings", although I can't find any independent
verification of this. Meanwhile, this
news story from the Belfast Telegraph
on Tuesday sets out Roads Service's case. Despite
Enda Kenny's purported comments, there is still no
indication that the Irish government intends to
withdraw its committment to funding the scheme as
made as part of the St Andrew's Agreement. On
Friday the d'Hondt system of sharing Ministries in
the newly convened Northern Ireland Assembly
resulted in the Department for Regional
Development Ministry (which includes roads)
falling to the Ulster Unionist Party
(previously it was held by Sinn Fein's Conor
Murphy who has championed this scheme). The UUP
leader Tom Elliott is known to be against this
scheme, so this may create some interesting
dynamics as this viewpoint clashes with others in
the coming months. But this essentially means that
the UUP will now decide the direction of transport
in Northern Ireland.
25 Apr 2011:
A series of pre-inquiry meetings were held between
6th and 11th April which were to "outline
procedural matters for the inquiries". We now know
that there will be four separate public inquiries,
starting follows:
- STRATEGIC (probably
considering the overall scheme and its
rationale) - starting 9th May 2011 at 10.30 am
in the Mellon Country Hotel, near Omagh.
- SECTION 1 (New Buildings to
Sion Mills) - starting 23rd May 2011 at 10.30 am
in the Fir Trees Hotel, Strabane.
- SECTION 2 (Sion Mills to
south of Omagh) - starting 6th June 2011 at
10.30 am in the Mellon Country Hotel, near
Omagh.
- SECTION 3 (South of Omagh to
Aughnacloy) - starting 20th June 2011 at 10.30
am in Kelly's Inn, Garvaghey, Ballygawley.
If
recent debate is anything to go by, these are
likely to be more impassioned public inquiries
than we have been used to in recent years. Roads
Service seem to be well aware of this, since they
have set aside almost two months for the
inquiries. Meanwhile the scheme appears to have
become a key election issue, with the UUP
manifesto (for example) including a committment
to re-thinking this scheme ("An urgent review
of the decision to commit over 50% of DRD’s next
budget to a road from Donegal to Dublin. We
advocate a refocusing on the need to commission
the A2 project at Greenisland, rather than the
A5 Western Transport Corridor") while the
Sinn Fein manifesto includes a committment
to press ahead with the scheme ("to address
regional inequalities in infrastructure –
particularly through the A5 Aughnacloy to Derry
major road scheme").
Of all Roads Service
schemes, this scheme currently has the highest
priority. There is still nothing to concrete to
suggest that the Republic of Ireland's financial
contribution will not bo forthcoming, so barring a
major change in the balance at Stormont the scheme
still looks likely to proceed.
14 Feb 2011: The Public Inquiry
has now been officially
announced. The statement does not give a
start date, other than to say that it will
probably be in May 2011. The Minister also said
that "because of the length of the project and
the extent of the interest, it has been decided
that the A5 Public Inquiry will be held at a
number of locations along the route". There
have been over 2000 objections to the scheme so it
seems likely that the Inquiry will have to sit for
an extended period of time.
10 Feb 2011: According to a written
answer two weeks ago, the Public Inquiry
into this scheme is anticipated to take place in
May/June this year, which is only four months
away. The answer also states that the benefit/cost
ratio of the scheme is estimated to be 1.74. This
ratio is a measure of how the economic benefits of
the road compare to the costs. Anything above 1.0
is positive. 1.74 is not the highest there is (the
A6 scheme from Dungiven to Londonderry is around
2.31) but equally some other schemes have a lower
value (the A2 at Greenisland is around 1.34). A
week ago the BBC
reported that the number of objections to
the project may have been exaggerated, since it
has been discovered that "scores of people
have complained that they did not send objecting
letters to Roads Service receivedin their name".
14 Jan 2011: The DRD has released
its draft budget for the period 2011-2015.
This shows that the A5 and A8 schemes are being
progressed at all costs - all other schemes (with
the exception of the Cherrymount Link in
Enniskillen) have been put on hold until at least
2015 in order to ensure there is sufficient money
for the A5 and A8. Even so, the budget assumes
that the £400m contribution from the Irish
government comes through (see previous update).
The decision to press ahead with the A5 and A8
will certainly provoke debate because (a) a number
of smaller schemes are being sacrificed to allow
the A5 and A8 to proceed (b) the Irish government
contribution carries a high risk of withdrawal (c)
the A5 is one of the most controversial in recent
years.
12 Dec 2010: In November there
appeared to be renewed certainty about the Irish
contribution to this scheme when the Irish
government released its budget committing to the
scheme. However, this certainty has unravelled
again in the past week with an indication that the
Irish Labour party may pull out of the agreement
if it gains power in the next General Election
(due on or before 14 July 2011). While there is,
of course, the complication that this funding was
part of the St Andrew's Agreement, their position
nevertheless seems clear: "At the present
time, we are experiencing savage cutbacks in
education, health and social welfare. Giving
Northern Ireland £400million towards its
roads is not a priority for the Labour Party.
... We are no longer in a position to fund the
section of the [Dublin-Derry] road in the south
so how could we fund the northern section?"
[Irish News 9 Dec 2010] . They are not
saying they will definitely pull out of the
scheme, but are saying that it is an option. If
the Irish funding (which represents 47% of the
total cost) is withdrawn it does not necessarily
scupper the plan, but it may affect its timescale,
whether it all proceeds at once and whether or not
their is a knock-on effect on other schemes in
Northern Ireland.
25 Nov 2010: With the economic
crisis in the Republic of Ireland reaching crunch
point yesterday, those involved in this scheme
eagerly waited news of what would happen to
Dublin's £400m contribution to this scheme.
The answer came in the last line of this
press release from the Irish Dept of
Transport yesterday. €20m of the cost has been
allocated from existing funds in 2011 and 2012,
while the the bulk of the cost (presumably the
bulk of the £400m) will be met from the
Capital Reserve Fund (CRF). Thanks to a site
visitor who e-mailed me with the details, I can
state that the CRF was first mentioned in the Capital
Expenditure Review of July 2010 which said:
"The revised Public Capital Programme also
incorporates a new ‘Capital Reserve Fund’. This
Fund will be used to finance emerging investment
priorities which may arise over the medium term.
The Fund will only be drawn upon in
circumstances where economic developments
present emerging opportunities for investments
which produce demonstrable net benefits to the
State." In other words, the fund has just
been announced and probably does not currently
exist. Presumably the intention is to create the
fund by 2013, but where the money to go into the
fund will come from is not stated. So I think we
are no clearer about the security of the Irish
contribution. Even with a 40% cut in capital
funding, Roads Service probably would have
sufficient funds to build the entire scheme
itself, but this would come at the cost of
postponing almost every other scheme in the next
five years. In other news, transport commentator
Christian Wolmar held a talk in Ballygawley
yesterday in which, according
to the BBC, he criticised the A5WTC scheme
in terms of (a) its cost and (b) its environmental
impact. However, the BBC report does not quote him
speaking in relation to the safety aspects of the
scheme - reducing deaths and serious injuries on
the A5 is Roads Service's primary justification
for the scheme. It has been suggested that a 2+1
upgrade of the existing road would be a better
option. This, however, would be unlikely to have a
significant impact on fatalities as most of the
causes of accidents would remain (eg right-turns,
large number of private accesses, lack of a
central safety barrier, inconsistent road
geometry, high speed differentials at junctions
etc) and would also require significant demolition
of homes.
17 Nov 2010: Roads Service held
the "Pre-Orders Exhibition" from 2-5 Nov 2010.
This is basically to set out the final, final
design. To their credit, the planners have
actually made a significant number of changes to
the proposed route after the previous round of
public exhibitions. Detailed maps of the entire
finalised route can be downloaded
here. Significantly, the design also shows
junction layouts for the first time which will
allow me (when time permits) to create a junction
strip map. The route features five at-grade
roundabouts (one at the southern terminus in
Aughnacloy, one with the A4 at Ballygawley, one in
Strabane where the road turns at 90° and two
at the northern terminus at Newbuildings). The
rest are a mixture of compact grade-separated
junctions and full-spec junctions such as on the
A32 Dromore Road in Omagh which is planned as a
full-scale roundabout interchange. The maps also
contain junction numbers, but these may be merely
labels for the diagrams rather than an indication
that the finished road will have junction numbers
like motorways do. The maps also show that the
recently-completed roundabout at Ballygawley is to
be demolished and the A4 dual-carriageway extended
by 1km to meet the line of the upgraded A5.
Despite significant
economic woes south of the border, the
Republic of Ireland agreed a payment schedule on
20 October for the £400m Dublin is to
contribute to the project, ie just under 50% of
the cost. This scheme has attracted opposition
that local road building has not seen since the
proposal to run a road through Lagan Valley
Regional Park was axed twenty years ago. This is
being led by the Ulster Unionist Party, which has
essentially come out against
the proposals. Opposition to the scheme
appears to be threefold: (a) the damage to
farmland (b) the environmental impact of a major
new road and (c) the high cost of the scheme. At
the same time, this
tragedy a week ago illustrates why something
needs to be done with this road. Nevertheless, the
scheme is being rapidly progressed and the draft
statutory orders were published a few days ago.
You can download them from here -
although there are literally hundreds of files
including details maps of the land to be vested.
The "Roads" Minister confirmed
last week that the public inquiry is still
planned for "mid 2011" with construction to begin
"2012-13".
17 Aug 2010: During the most
recent round of public consultations a substantial
number of landowners wished to discuss
alternatives to the Preferred Route, which was
announced last summer. Roads Service took down
these suggestions and has recently completed a
study into each of them, available
here. In 12 cases they have recommended that
the suggested alternatives be adopted, rather than
the preferred route. In 20 further cases, the
alternatives have not been adopted. The document
briefly explains why in each case. The document
once again rejects the possibility of an online
upgrade, as the reasons for its objection outlined
in early 2009. It should also be stated that there
is a sizeable level of local opposition to the
entire scheme, not only from farmers but other
stakeholders as well. Last
week a group of travelling environmentalists
set up a temporary camp called "Climate Camp" near
Victoria Bridge to protest against the scheme. A
group referring to itself as the "Alternative
A5 Alliance" has also been set up to
campaign for the project to be scrapped and
replaced by a reinstatement of the former railway
line. However it is difficult to judge just how
much in favour or in opposition the general public
in Tyrone are. The Belfast
Telegraph last week published a piece
setting out arguments both for and against the new
road.
23 Jan 2010: In
the Assembly on 18th January, the deputy
First Minister reported on a meeting held by the
North-South Ministerial Council which discussed
the A5. He reported that the Irish government made
a payment of €9 million in December, which
represents a small initial amount of the
£400m that they have committed to the
scheme. The Irish government also re-committed
themselves to the scheme, which the deputy First
Minister described as important, "in view of
the debate on the economic situation North and
South". He also recognised that some
landowners are opposing the scheme for various
reasons, but he has chosen to take quite a strong
stance on this when he said "let nobody be in
any doubt whatsoever that [the A5 and A8
schemes] will go ahead. They are vital for us if
we are to develop the economy and a road
infrastructure that will allow us to attract
inward investment."
14 Dec 2009:
Last week the DRD officially
announced the names of the three contractors
that have been appointed to undertake the detailed
design and construction of the three phases. The
final list is as follows, confirming that the
details publicised a month ago (see below) was
correct:
- Section 1 (northern part) - Balfour
Beatty/BAM/FP McCann Joint Venture
- Section 2 (central part) - Roadbridge/Sisk/PT
McWilliam Joint Venture
- Section 3 (southern part) - Graham/Farrans
Joint Venture
16 Nov 2009:
In the Assembly today,
the Minister of Regional Development reaffirmed
that both he and his Southern counterparts are
committed to this scheme, saying "If elected
representatives continue to question it, they
may create a degree of uncertainty about the
project. On every occasion that we have been
asked about it, the commitment from the
authorities, North and South, has been restated
and confirmed". However, while the
political will is definitely there, I believe
there is still a genuine question mark in the
current financial climate over whether or not the
high level of funding required will be available
in time to meet the tight construction timetable.
In any case, the contracts for construction are
due to be announce soon, but the information I
have says that the appointed contractors will be
as follows (unverified and subject to change):
- Section 1 (northern part) - F.P.McCann/Balfour
Beatty/BAM consortium
- Section 2 (central part) - Roadbridge/Sisk/ PT
McWilliams consortium
- Section 3 (southern part) - Farrans /Grahams
JV
This information is to be
confirmed by the end of November.
2 Nov 2009:
Roads Service have given
more details of the timescale for the scheme
over the next few years:
- "An Emerging Specimen Design will be
presented to the public in summer 2010.
- The Statutory Orders will be published in late
2010 and will be examined at a public inquiry in
2011."
- Construction is still anticipated to begin in
2012, subject to the public inquiry.
This assumes that the
funding is available at the time of construction.
However, to date, the Republic of Ireland has
given no indication that their contribution will
not be forthcoming despite the uncertain financial
climate.
16 August 2009: A more detailed
version of the preferred route is now available on
the "interactive map" on the official A5 web site
here.
A few other comments can be made since the
previous update. Firstly, a detailed look at the
alignment of the road past Strabane strongly
suggests that the junction between the A5 and the
N14/N15 to county Donegal may be an at-grade
roundabout. This is because the A5 appears to take
a very steep corner here, much too steep for a
flowing road. Of course it is also possible that
the junction could take the form of a trumpet
interchange with the southern end of the A5
flowing directly onto the N14, while the northern
part of the A5 is the joining road. This would be
a much better option, as major roads like the A1
have been plagued for years by isolated
roundabouts such as the one at Hillsborough which
cause unnecessary congestion. Michelle Greer, who
is the project manager for the central portion of
the A5 project, wrote to me to clarify the
standard of junctions. She said "we are
designing the road to Category 6 under the DMRB
(Design Manual for Roads & Bridges... This
means that at the lower end of that category we
could end up with at-grade junctions (ie
roundabouts) and left in/left out junctions
along its length. However it also allows for
grade separation of junctions... it is not yet a
given that all major junctions will be grade
separated." This is useful clarification
and relevant to the Strabane question. Aso, a site
visitor reported that they were told at the public
exhibition that the A5 passes quite close to Omagh
in order to encourage as much traffic as possible
off the local road network and onto the new road.
Finally, the cost has now been estimated as
£844m. This is at the upper end of the
£650m-£850m estimate made back in
November 2008, and means that the Irish
government's contribution of £400m will pay
for less than half the cost of the scheme, with
Roads Service left to find £444m to fund it.
23 July 2009: The preferred
route was
announced on Tuesday, as expected, and was
generally in line with what we knew from Noel
Dempsey's leak last week. Click
here for a PDF of the route. Notable
elements of the plan include the fact that the
road will start south of Newbuildings,
with a single-carriageway bypass of Newbuildings
leading into Derry itself. This decision will both
reduce disruption to property in the south of the
city, and suggests that the concept of providing
links to the A2 west of the city and the A6 east
of the city may proceed. At Strabane, the decision
has been made to go west of the town,
between the town and the river. The northern part
of this route seems to run either on or close to
the existing Strabane Bypass, while the southern
part seems to take an offline route further west
than the Bypass. The road takes an almost entirely
offline route from there all the way to
Aughnacloy, which will leave the current road
largely intact. It bypasses Newtownstewart to the
west (eliminating the need for two more
bridges on the existing Newtownstewart Bypass).
The road swings by Omagh on the west side,
choosing one of the options that is closer to the
town. The route crosses the A4 west of the
existing (and new) Ballygawley roundabouts, does not
utilise the current realignment work at Tullyvar
and finally bypasses Aughnacloy on the eastern
side to connect with the N2 in county Monaghan.
All told, the proposed route seems fair enough. If
it happens (which will be dependant on money) it
will be a very impressive scheme with the
potential to reduce journey times on the entire
route by 20 minutes.
14 July 2009: A
week before it was due to be announced, Irish
Minister for Transport, Noel Dempsey, has accidentally
leaked the preferred route of the scheme via
a photograph on his web site! The picture is not
very clear, but it is possible to discern the
route (thick black line) against the current A5
(thin red line). The route appears to include the
following elements:
- Close to or on the current A5 alignment from
Newbuildings to Strabane
- Round the west side of Strabane
- Generally offline to the west of the current
A5 between Strabane and Omagh
- Round the west of Omagh, but relatively close
to the town
- Offline quite far to the south-west of the
current A5 from Omagh to Ballygawley
- Round the eastern side of Aughnacloy.
This information is due to
be publicly announced by Conor Murphy on 21st July
in Omagh. With thanks to Kieran4003 who
spotted this picture.
12 July 2009:
Following the forthcoming announcement of the
preferred route for the scheme (21 July) Roads
Service and Mouchel (the consultants) will be
holding public exhibitions as follows:
- Mon 27 July 2009: Silverbirch Hotel, Omagh
12pm - 9pm
- Tue 28 July 2009: Fir Trees Hotel, Strabane
12pm - 9pm
- Wed 29 July 2009: Everglades Hotel,
Londonderry 12pm - 9pm
- Thu 30 July 2009: St Ciaran's College,
Ballygawley 12pm - 9pm
As always, I would strongly
encourage all those with an interest in the scheme
to turn up at one of these events as they are the
main way to get your views heard.
23 June 2009: The word on the
street is that the preferred route for this scheme
will be announced in Omagh on 21st July 2009. This
is when we will finally know where Roads Service
plan to put the road (subject to the public
inquiry).
23 May 2009:
The Regional Development Minister gave an update
on the scheme to the Assembly two weeks ago.
He said that the selection of preferred route
would be completed in "mid 2009", with the draft
statutory orders (legal papers required to
progress the project) published "by late 2010". He
also said that the procurement process was now
underway - divided into three simultaneous
phases:
- Contract 1 - 25km from New Buildings to south
of Strabane, including ca. 4 major junctions
- Contract 2 - 34km from south of Strabane to
south of Omagh, including ca. 4 major junctions
- Contract 3 - 36km from south of Omagh to
Aughnacloy, including ca. 3 major junctions
As this project is
dependant on £400m from the Republic of
Ireland, there is public concern that in the
current Recession the Republic may withdraw this
promise. However the Minister said that he had
been "very forcefully assured... that funding will
be forthcoming", and that he has been assured of
this a number of times by various people including
the Taoiseach.
6 March 2009: The public
consultations happened in February as planned, and
the response was described as "phenomenal" and
"positive". Lots of PDF files outlining the
current position and detailed maps of the four

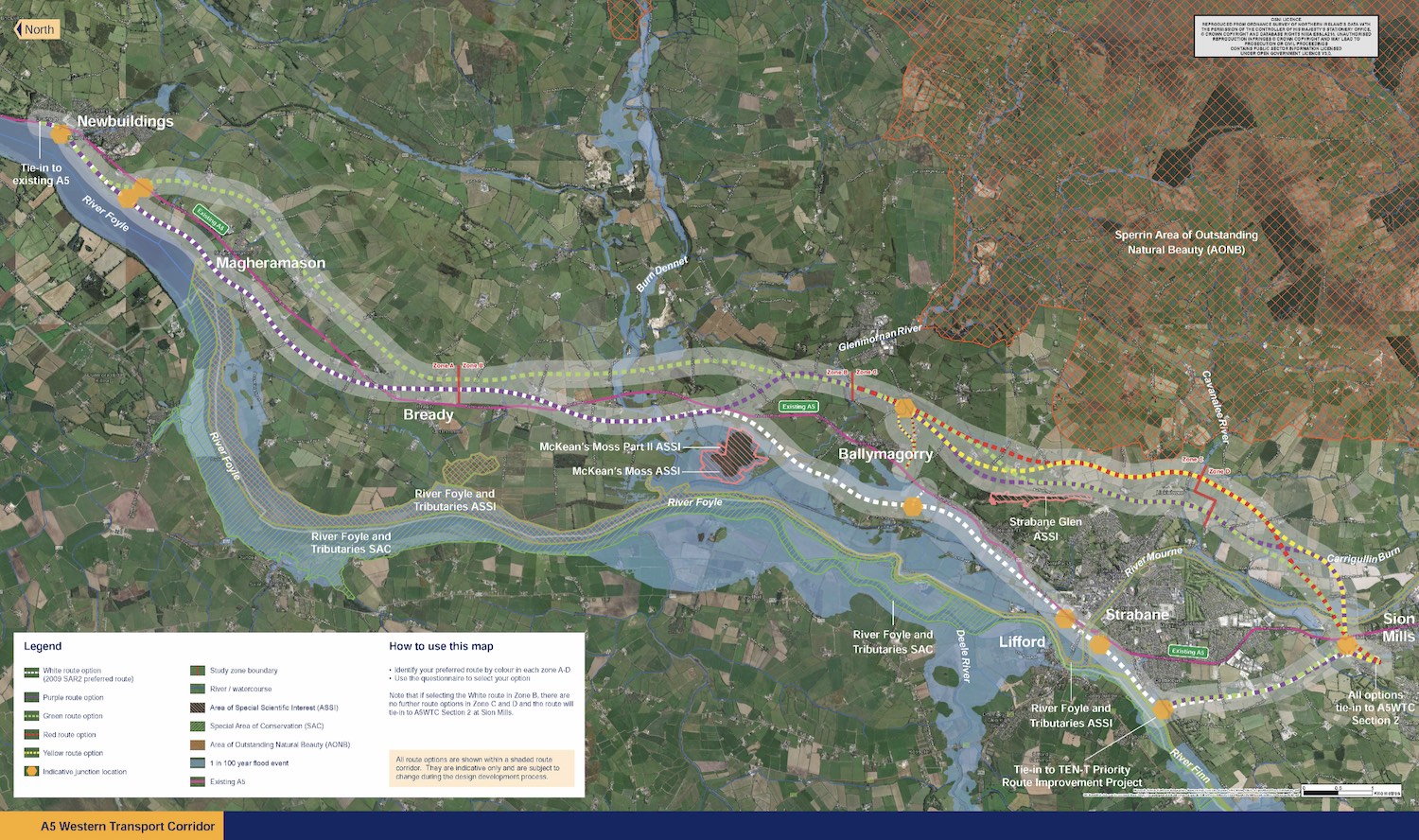

route options now being considered can be downloaded
from here. These documents suggest that the
preferred route will be announced in the summer of
2009, a final accouncement in Autumn 2010, public
inquiry perhaps in 2011 with construction perhaps
in the period 2012-2015. This is an ambitious
timetable, and will be subject to the availability
of finance when the time comes. The confirmation
that the scheme will have a continuous central
reservation is excellent news, and the junction
locations seem very appropriate. The only slight
disappointment is that there will just be 1 metre
hard strips, rather than full hard shoulders. Hard
shoulders are an important safety feature since
they allow broken down motorists to get their
vehicle fully clear of the fast moving traffic,
although they do admittedly add several metres to
the road width. Finally, one of the members of the
A5WTC team e-mailed me to confirm that the
estimated cost of the scheme remains
£650-£850m. The
£500m-£600m mentioned in February's
update is merely the construction cost,
ie not including land, fees etc. With thanks to
that person for the clarification.
12 Feb 2009:
Roads Service have announced that the next round
of public constulations will take place in mid
February. This is part of the process of selecting
the actual route within the route corridor
announced in November last year. All interested
parties should be encouraged to attend these
events as this is one of the key opportunities to
have your opinions heard. The events are taking
place as follows:
- Omagh: Tuesday 17 February
2009, 12pm-9pm, Silverbirch Hotel, Gortin Road
-
Ballygawley:
Wednesday 18 February 2009, 12pm-9pm, Smyth
Memorial Hall, Church Street
-
Strabane:
Tuesday 24 February 2009, 12pm-9pm, Fir Trees
Hotel
- Derry: Wednesday 25 February
2009, 12pm-9pm, Everglades Hotel
In addition, notice of the
tender for the actual construction has
appeared on the Roads Service web site. The
tender is due to be released this month and it
confirms that the project will be carried out as three
similarly sized, but separate, tenders. Operators
will only be allowed to tender for two of these.
This was widely anticipated as the project is much
larger than any other single road project in
Northern Ireland's history. The information gives
the estimated value of the scheme as
£500m-600m, substantially less
than the figure of £650m-850m quoted in last
November's initial report. Despite the economic
downturn on both sides of the border, the DRD is
adamant that this project will proceed as planned.
10 Nov 2008: The next phase of
the project has been completed. Having looked in
the general area of the A5 (an area up to 15km
wide) the team have now narrowed down the route of
the dual-carriageway to a much narrower area,
which ranges in width from 500 metres to about
3km. This area is known as the "preferred
corridor" and is an essential step because the
study area is so huge that simply drawing a line
on the map is not possible. You can see the
preferred corridor on the interactive map here
(the area bordered by the dotted red line). Work
has now begun on drawing various route options
within this preferred corridor, and it is
anticipated that these options will be on display
at a public consultation in February or March
2009. A description of the route is given above,
and you can read the very detailed initial report
on the A5 project web site www.a5wtc.com. This
report has estimated the cost at
£650m-£850m, considerably more than
originally estimated (£540m-£660m).
Although the economic situation is now dire,
putting question marks in people's heads over the
viability of either Stormont or Dublin being able
to afford this very expensive road, the Regional
Development Minister is insisting that it will go
ahead and that it is is on schedule.
28 Apr 2008: The document "Investment
Delivery Plan for Roads", released in 2008,
includes this scheme in the "preparation pool" of
schemes likely to proceed by 2013. Given the
enormous size of the project, it is hard to see
work on all parts of the route proceeding
simultaneously, but we shall see. Also, an
official web site has been set up for the scheme
at www.a5wtc.com.
Information on the site is still relatively
scarce, but that is due to the fact that the
scheme is at an early stage and not many decisions
have been made at this point.
16 Dec 2007: According to the Strabane
Chronicle last month, the timescale for the
first phases of the project are that the general
route corridor will be announced at the end of
2008. This is a general path, perhaps a mile or so
wide, that determines things like which sides of
major towns the route will go but is not the
specific route. Apparently the exact "preferred"
route will be announced in mid 2009. The preferred
route is, of course, then subject to public
inquiry. Conor Murphy, Regional Development
Minister, is quoted as saying in the article that
the funding for the scheme has been "ring fenced"
and that it will be "fast tracked". It's unclear
what this actually means in terms of the normal
processes.
Note on
Costs
In 2007 the Irish government offered £400m
to the Northern Ireland Executive to be used for
the upgrade of the A5 between the Irish border
near Aughnacloy and Londonderry, and the A8
between Newtownabbey and Larne. In July 2007 the
Executive accepted the funding. In November
2007 the Executive announced that they
would proceed with both schemes at a total
cost of £660m. At the time of the preferred
route corridor announcement of November
2008 the cost of the A5 scheme alone
was given as between £650m and £850m,
depending on whether or not the junctions were
grade separated (ie flyovers). In a Written Answer
in November 2009, the Minister said
that the total cost of all three components
of the scheme taken separately was £1.11
billion, but insisted that the cost of the
combined scheme was still in the region
£650m to £850m. As of January
2011 the total cost for the A5 scheme
alone is being given as £844m.
Note that in 2004, before the Irish had made
their offer, a UK
study estimated the cost of this scheme as
between £346m and £480m depending on
the ambitiousness of the design. Land and property
prices will have risen since then, but the figures
seem to be in the same ballpark.
|
